Power and Construction Bottlenecks Threaten Up to 50% of Planned 2026 Data Center Capacity
A severe shortage of heavy electrical equipment and grid interconnection delays are stalling the construction of new AI data centers. As a result, operators are increasingly pivoting to on-site power generation to bypass the grid entirely.
By Naina Verma
Share this story
For the past two years, the artificial intelligence industry has been defined by a single, agonizing bottleneck: the supply of advanced graphics processing units. Today, silicon manufacturing has largely caught up to demand. But as tech giants take delivery of billions of dollars worth of chips, they are colliding with a much older, heavier constraint. There is simply not enough physical infrastructure to plug them in.
A new market outlook from energy intelligence firm Currence reveals the stark reality of the 2026 data center landscape. Between 30% and 50% of the large-scale data center capacity expected to come online this year is facing severe delays. The industry is currently announcing projects far faster than it can pour concrete or pull copper wire.[1]
The numbers highlight a massive execution gap. Developers have scheduled approximately 16 gigawatts of new capacity to begin operations in 2026. However, only about 5 gigawatts of that capacity is actively under construction. The remaining 11 gigawatts sit in the announced stage with no visible physical progress, despite typical build timelines of 12 to 18 months.[1]

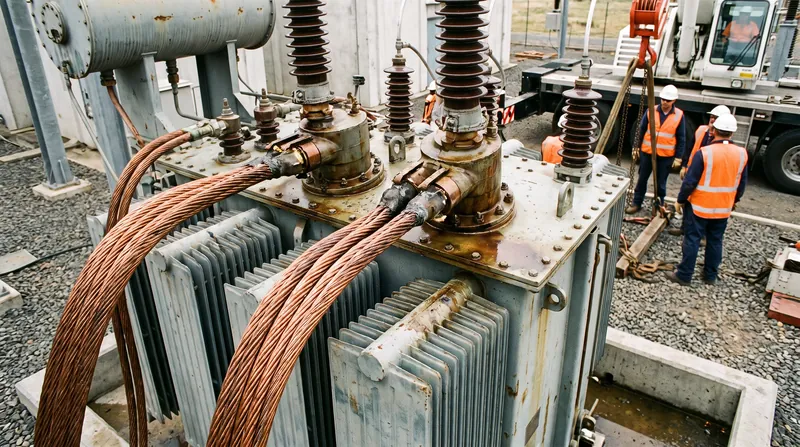

The primary culprit is not a lack of capital, but a severe shortage of heavy electrical equipment. High-voltage transformers, switchgear, and grid-tie batteries are the gating factors for new facilities. Before 2020, the lead time for a high-power transformer was roughly 24 to 30 months. Today, that wait has stretched to five years, leaving developers stranded in interconnection queues.[7]
The financial sector is beginning to react to these stretched timelines. Banks are actively reshuffling their lending portfolios to manage their exposure to the booming, yet increasingly delayed, sector. In a telling move, a lender recently attempted to offload a portion of a loan backing a major Hong Kong data center project, signaling that financial institutions are hitting their internal sector limits as projects take longer to yield returns.[3]

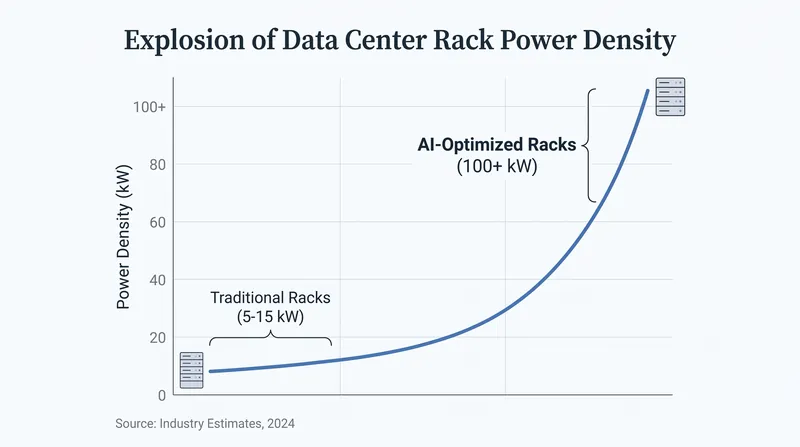

To understand why the grid is buckling, one must look at the physical mechanics of artificial intelligence. Traditional cloud computing data centers were designed for racks that draw between 5 and 15 kilowatts of power. AI-optimized racks, packed with dense clusters of chips, demand anywhere from 30 kilowatts to over 100 kilowatts per rack.[8]
This extreme power density fundamentally changes the relationship between a data center and its local utility. A single modern AI facility can require 100 to 750 megawatts, which is the equivalent power draw of a medium-sized city. Existing grid substations were never engineered to support such concentrated, inflexible loads.[8]
Furthermore, the nature of AI workloads has shifted. During the initial boom, the focus was on training massive models, which is a burst workload that is intense but periodic. Today, the vast majority of the compute load is inference, the continuous process of models generating responses for end users. Inference requires firm, sustained power without interruption.[8]
The aggregate impact of this shift is staggering. Gartner forecasts that global data center electricity consumption will surge 26% year-over-year to reach 565 terawatt-hours in 2026. AI-optimized servers alone are projected to account for 31% of that total power consumption, up from a fraction just a few years ago.[2]

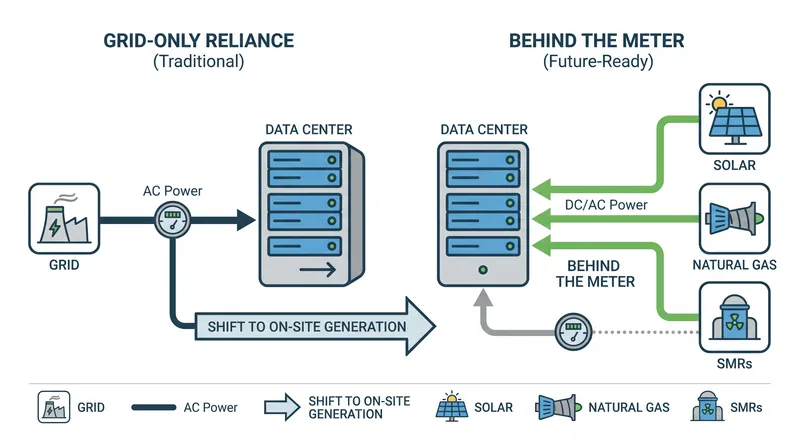

Faced with multi-year grid delays, the technology industry is rapidly pivoting its strategy. The new mandate is power independence. Rather than waiting for utility companies to upgrade public transmission lines, data center operators are moving behind the meter, investing directly in on-site power generation.[4]
A 2026 report from Bloom Energy indicates that expectations for fully on-site-powered data centers have jumped 22% in the last six months. By 2030, roughly one-third of all data centers are expected to operate entirely on their own power microgrids, utilizing a mix of natural gas fuel cells, solar arrays, and eventually small modular nuclear reactors.[4]
Beyond power generation, operators are rethinking the physical architecture of the data center itself. Liquid cooling systems are replacing traditional air conditioning, piping coolant directly to the chips to manage the immense heat generated by high-density racks. This shift maximizes the computational output for every watt of electricity consumed.[8]
Yet, even when power is secured, the sheer logistics of building at a gigawatt scale present their own hurdles. Constructing these mega-facilities involves dozens of active subcontractors and hundreds of truck movements per week. Structural steel, cooling infrastructure, and electrical switchgear must arrive in precise sequences under strict security protocols.[5]
When a single delayed transformer can push a facility's opening back by a year, the carrying costs of empty data center shells and depreciating, unpowered hardware become a massive financial burden. The winners in the current landscape will not necessarily be those with the best algorithms, but those who locked in their power purchase agreements years in advance.[6]
Ultimately, the artificial intelligence boom has forced the software industry to collide with the physical world. As hyperscalers and colocation providers navigate these construction and power bottlenecks, they are transforming from pure technology companies into some of the world's largest energy and infrastructure developers.
