The Evidence on Large-Load Tariffs: How Utilities Are Shifting Grid Risk to Data Centers
A new analysis of 55 utility tariffs reveals how power providers are using exit fees, 12-year minimum contracts, and ramp schedules to protect residential ratepayers from the financial risks of the data center boom.
- Grid Researchers and Planners
- Focus on documenting and implementing tariff structures that protect existing ratepayers from stranded assets.
- Policy and Consumer Advocates
- Emphasize the risk of retail price spikes and the necessity of strict cost-allocation frameworks.
- Editorial Synthesis
- Evaluates the systemic shift in how the U.S. power sector allocates the financial risks of the data center boom.
Perspectives this story doesn't cover
- Data center developers
- Hyperscale tech companies
Summary
- LBNL and the Brattle Group analyzed 55 utility tariffs designed to manage the risks of rapid data center and industrial load growth.

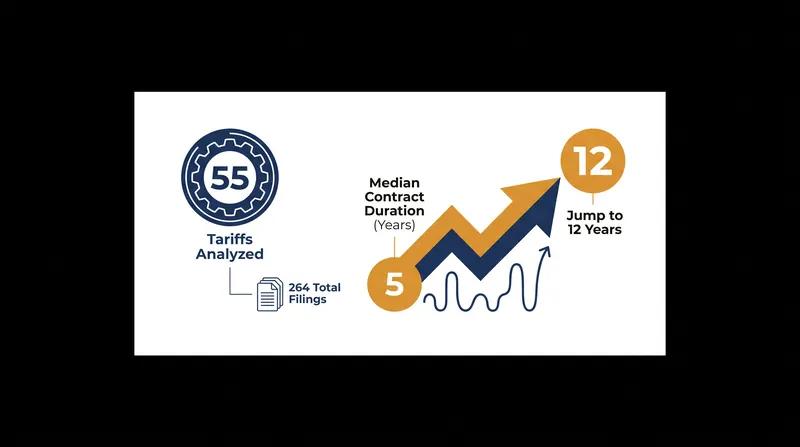

- Median minimum contract durations for large loads have more than doubled since 2025, rising from five to 12 years.
- Emerging tariff provisions increasingly require upfront payments for system impact studies and strict load ramp schedules.
- The regulatory shift aims to prevent residential ratepayers from absorbing the costs of stranded grid assets if tech facilities close prematurely.
On August 31, 2026, the Lawrence Berkeley National Laboratory (LBNL) and the Brattle Group released an updated analysis of 55 large-load tariffs, documenting a sharp regulatory pivot in how utilities allocate the financial risks of the data center boom. The technical brief, which builds on a baseline study from January 2025, isolates 18 distinct elements that power providers are using to insulate their broader customer bases from the volatility of hyperscale tech infrastructure.[1][2]
The sheer volume of regulatory activity underscores the stakes. According to data from Halcyon’s Large Load Tariff Tracker, 264 tariff filings involving data centers, advanced manufacturing, and large industrial customers had been cataloged by mid-August 2026. This surge in filings represents a systemic effort by utilities and state public utility commissions to answer a fundamental question: who pays for the grid upgrades if a massive new facility fails to materialize or shuts down early?[1][2][4]

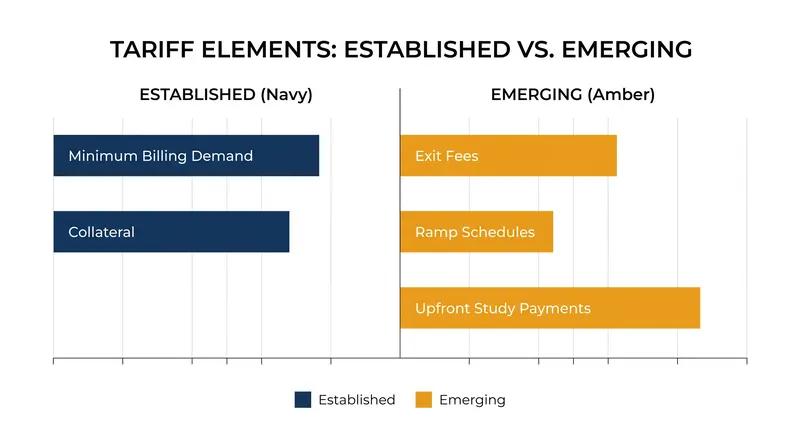

The LBNL and Brattle researchers divided the tariff provisions into "established" and "emerging" practices. Eight established elements now appear in more than two-thirds of the reviewed tariffs. These include minimum demand thresholds, alongside monthly demand charges, collateral requirements, and direct assignment of costs. These elements vary significantly in practice, however. "For example, while every tariff the researchers examined in 2026 required customers to exceed a minimum demand threshold, that value ranged from less than 1 MW to 150 MW," Natalie Mims Frick, leader of the energy markets and planning department at LBNL, said in a presentation.[1][2]
However, the 2026 update reveals that utilities are increasingly deploying a second tier of "emerging" provisions designed to address long-term uncertainty. More utilities are now requiring prospective large-load customers to pay upfront for system impact studies before any infrastructure work begins. This shifts the initial speculative risk away from the utility and forces developers to demonstrate financial commitment before entering the interconnection queue.[1][2]
However, the 2026 update reveals that utilities are increasingly deploying a second tier of "emerging" provisions designed to address long-term uncertainty.
The duration of that commitment is also expanding rapidly. The median minimum contract duration among tariffs proposed since 2025 has jumped to 12 years, compared with just five years among earlier frameworks. By locking facilities into longer agreements, regulators are attempting to match the lifespan of the customer contract to the amortization schedule of the transmission and distribution assets built to serve them.[1][2]
Load ramp periods have emerged as another critical tool. These schedules establish exactly how quickly a customer must reach its contracted demand. If a data center developer requests 100 megawatts of capacity but only draws 20 megawatts during its first three years of operation, the utility is left with stranded capacity that it cannot sell to other customers. Ramp schedules penalize facilities that hoard grid capacity without utilizing it.[1][2]
To enforce these timelines, newer tariffs are incorporating strict exit fees and capacity-reassignment provisions. If a large-load customer reduces or terminates service before the utility's investments are fully recovered, these fees ensure the departing company covers the shortfall. Hold-harmless mechanisms are also being written directly into the tariffs, explicitly stating that existing residential and commercial ratepayers will not subsidize the costs of serving the new load.[1][2]
State legislatures and advocacy groups are increasingly directing public utility commissions to formalize these protections. Climate XChange, which reviewed over 140 bills addressing data centers across 34 states in 2025 and 2026, recently published toolkits urging states to mandate large-load tariffs that shield ratepayers from the risk of stranded assets. These frameworks give public utility commissions firmer ground to review and approve tariffs that address energy users with a massive footprint on the grid.[3]
The tension between rapid technological deployment and grid stability remains unresolved. While the LBNL and Brattle analysis demonstrates that utilities possess the regulatory tools to protect existing ratepayers, the implementation of these tariffs varies wildly across jurisdictions. As the median contract length stretches to 12 years and upfront capital requirements grow, the U.S. power sector is effectively forcing the tech industry to underwrite its own expansion.[1][2][4]
Limits of the evidence
- Whether these protective tariff structures will survive legal challenges from tech companies arguing they are discriminatory.
- How effectively exit fees can actually be collected if a large-load customer declares bankruptcy before the utility recovers its infrastructure investment.
- The exact threshold at which stringent grid interconnection requirements begin to drive data center developers to build their own off-grid generation.
Sources
[1]Lawrence Berkeley National LaboratoryGrid Researchers and PlannersElectricity Rate Designs for Large Loads: Evolving Practices and Opportunities 2026 Update
Read on Lawrence Berkeley National Laboratory →
[2]Utility DiveGrid Researchers and PlannersLarge-load tariffs increasingly rely on upfront payments, exit fees, ramp schedules
Read on Utility Dive →
[3]Climate XChangePolicy and Consumer AdvocatesState Policy Toolkits for Data Center Regulation
Read on Climate XChange →
[4]Factlen Editorial TeamEditorial SynthesisSynthesis by Factlen editorial team
Read on Factlen Editorial Team →
Comments
More in Energy
See all →Reactor Physics
How the Scattering-to-Absorption Ratio Dictates a Nuclear Reactor's Fuel Enrichment
5 sources
Refining Tech
The Zeolite Catalyst and 500°C Temperature That Dictate a Refinery's Gasoline-to-Fuel Oil Ratio
6 sources
Hydrogen Pathways
The Carbon Intensity Gap Between Steam Methane Reforming, Electrolysis, and Pyrolysis
8 sources
Carbon Tariffs
Quantifying the Carbon Leakage Penalty: How the EU CBAM Prices Embedded Emissions in Imported Steel
5 sources
Every angle. Every day.
Get Energy stories with full source coverage and perspective breakdowns delivered to your inbox.
