Dominion's 2.6 GW Offshore Wind Project Cost Jumps $300M Due to Grid Upgrades and Tariffs
The largest offshore wind farm in the United States is now 81% complete and generating power, but its final price tag has risen to $11.65 billion following grid interconnection revisions and new federal tariffs.
Share this story
The Coastal Virginia Offshore Wind (CVOW) project is a historic piece of American engineering. Situated 28 miles off the coast of Virginia Beach, it is designed to be the largest offshore wind farm ever constructed in the United States.[4]
During its second-quarter 2026 earnings update, Dominion Energy revealed that the massive infrastructure project has reached an 81% completion milestone.[1]

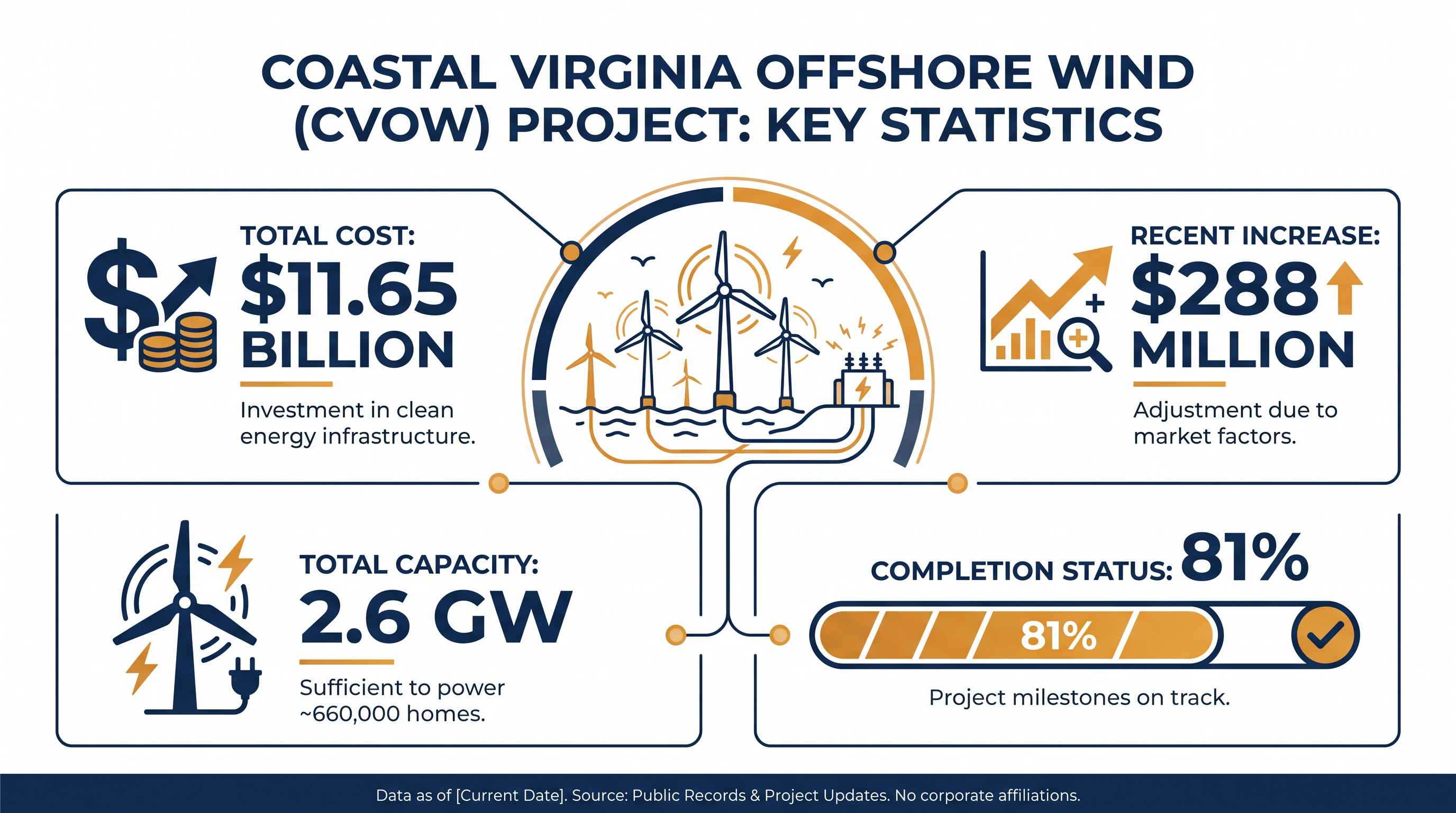

However, the final stretch of construction will require more time and capital than previously projected. The total budget has increased by approximately $288 million, bringing the final estimated price tag to $11.65 billion.[1]
Furthermore, the installation of the 176th and final turbine has been pushed back by six months, with completion now targeted for the end of 2027.[1][3]
While a nearly $300 million cost increase sounds staggering in isolation, it represents a roughly 2.5% adjustment on a project of unprecedented scale.[1][3]
The budget revision is driven by three specific factors: complex onshore grid upgrades, recent federal trade tariffs, and the physical realities of operating heavy machinery on the Atlantic seafloor.

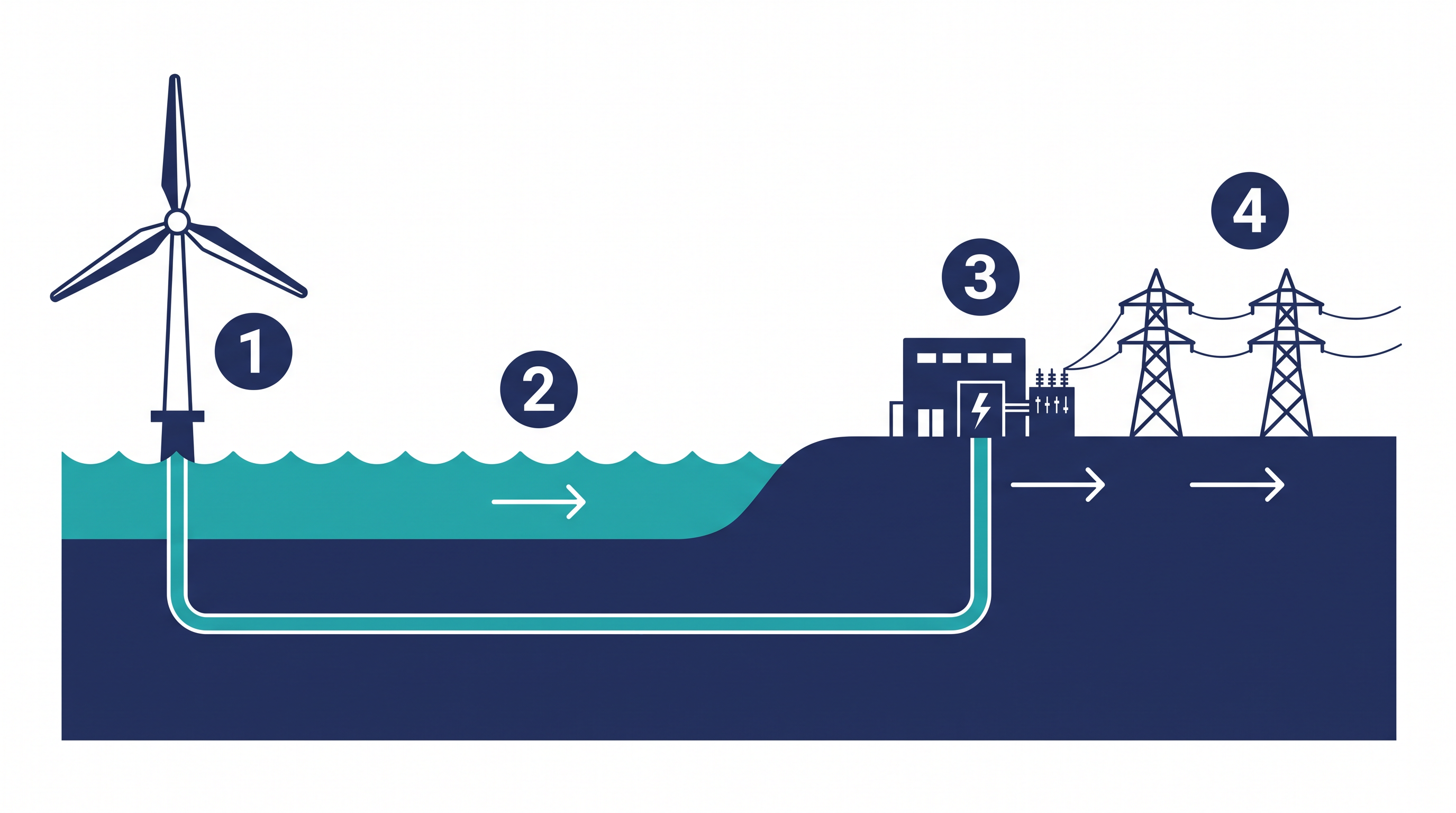

Connecting 2.6 gigawatts of new electricity to the mainland is not as simple as running a subsea cable to the beach. It requires extensive onshore infrastructure to safely absorb and route the power.
This integration is overseen by PJM Interconnection, the regional transmission organization that coordinates the wholesale electricity grid across 13 states and Washington, D.C.[5]
When a massive new generation source like CVOW comes online, PJM mandates "network upgrades" to the broader grid to prevent transmission bottlenecks and ensure system reliability.[5]
Historically, the developers of new power plants bear a significant portion of these upgrade costs. During the second quarter, Dominion navigated a complex reallocation of these PJM-assigned liabilities, which contributed to the shifting budget.[1]
The second major driver of the cost increase is international trade policy. In April 2026, the federal government imposed new tariffs on imported clean energy components.[1]
These tariffs added an estimated $228 million in unexpected costs to the CVOW budget.[1]
While Dominion is utilizing the Charybdis—the first Jones Act-compliant wind turbine installation vessel built by American shipyard workers in Texas—the broader offshore wind industry still relies heavily on global supply chains for specialized subsea cables and transition pieces.[4]
The third factor extending the project's timeline is the physical challenge of deep-ocean construction.[1][3]
Each turbine tower stands roughly as tall as a 38-story building and must be anchored to the seabed using a massive steel monopile foundation.[4]
Dominion reported that harder-than-expected subsea conditions at certain turbine locations required longer "jacking" durations—the process by which the installation vessel lifts itself above the waves on mechanical legs to provide a stable lifting platform.[1][3]
Pushing the final installation date to late 2027 also provides the project with a necessary weather contingency buffer, acknowledging the unpredictability of the Atlantic hurricane season.[1]
Despite the delays and budget adjustments, financial analysts and Dominion's leadership maintain that the project is now substantially de-risked.[1][3]

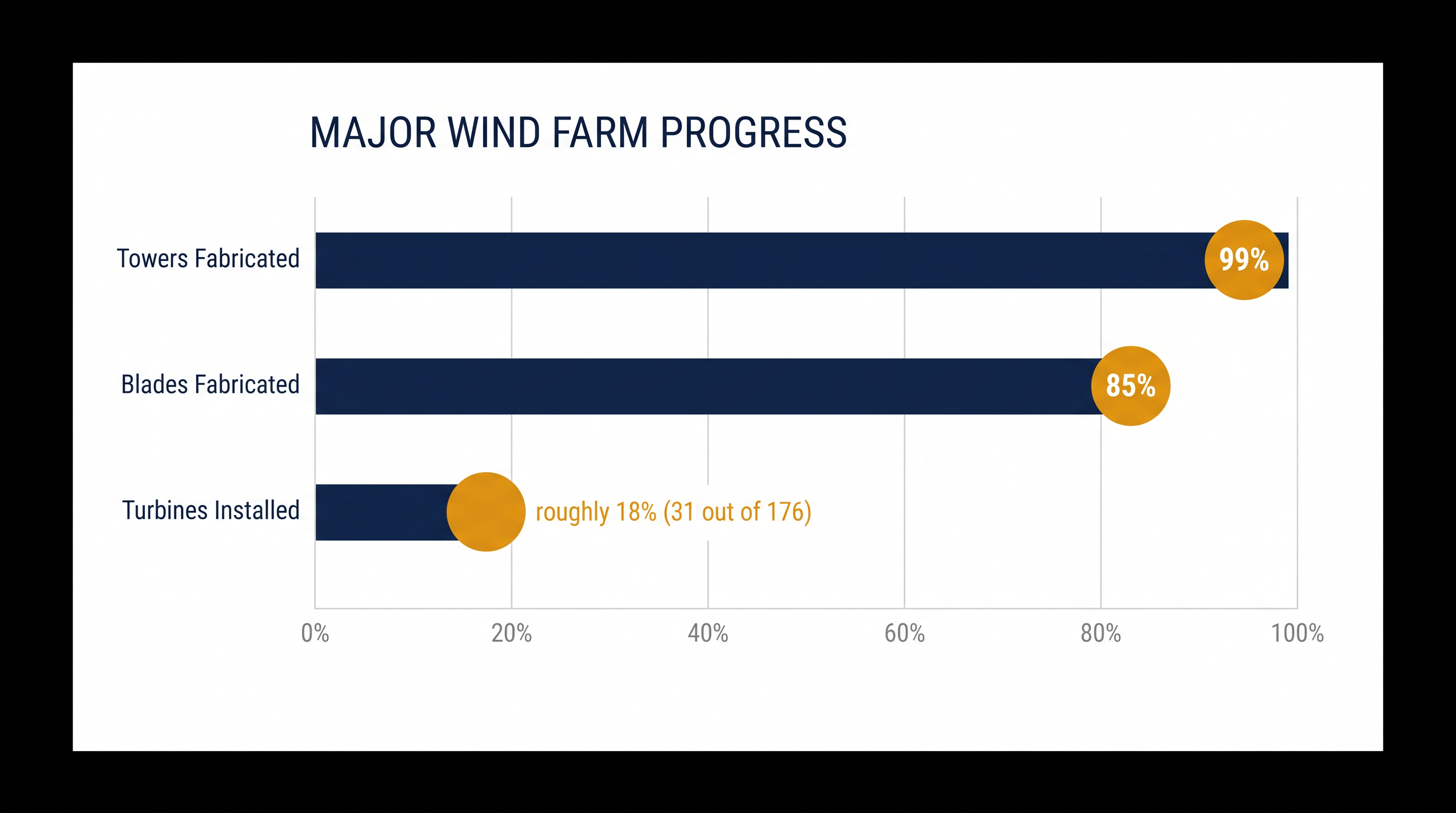

The theoretical risks of manufacturing are largely in the rearview mirror: 99% of the steel towers and 85% of the composite blades have already been fabricated.[1]
Viewpoints in depth
The Utility's View
Dominion Energy views the project as substantially de-risked despite the recent cost adjustments.
From the developer's perspective, a $288 million increase on an $11.65 billion budget is a manageable 2.5% variance, especially for a first-of-its-kind mega-project. Dominion's leadership emphasizes that the heaviest risks—manufacturing the massive components and proving the installation concept—have already been retired. With 81% of the project complete and 450 megawatts already generating revenue and fuel savings, the utility argues that the delayed timeline reflects prudent weather contingencies rather than systemic failure.
The Grid Operator's View
PJM Interconnection must ensure that adding 2.6 gigawatts of power does not destabilize the regional grid.
Regional transmission organizations like PJM operate under strict reliability mandates. When a massive influx of intermittent renewable energy is proposed, the existing onshore transmission lines and substations must be upgraded to handle the load. PJM's cost allocation rules are designed to ensure that the developers triggering these necessary network upgrades bear a proportionate share of the financial burden, protecting existing ratepayers from subsidizing corporate generation assets.
The Market Analyst's View
Financial markets are weighing the cost of delays against the utility's steady earnings guidance.
For market analysts, the six-month delay and $288 million cost bump are blemishes on an otherwise strong quarter. However, because Dominion has maintained its long-term earnings per share (EPS) guidance and successfully completed its equity financing programs, the market has largely priced in the delay. Analysts note that as long as the project continues to hit its revised installation targets and the cost-sharing agreements protect the utility's balance sheet, the long-term compounding value of the asset remains intact.
Key points
- Dominion Energy's Coastal Virginia Offshore Wind project is currently 81% complete.
- The total project budget has increased by roughly $288 million to $11.65 billion.
- The cost increase is driven by PJM grid upgrades, federal tariffs, and subsea installation challenges.
- Final turbine installation has been delayed by six months to the end of 2027.
What we don’t know
- Whether the remaining 145 turbines will encounter further subsea jacking delays during installation.
- How future shifts in federal trade policy might impact the cost of replacement parts or ongoing maintenance.
- The exact final impact on Virginia residential utility bills once the project is fully amortized over its lifespan.
