Mobile Megawatt Charging vs. Fixed Infrastructure: The Economics of Class 8 EV Fleet Power
As heavy-duty electric trucks hit the market, fleet operators face a critical infrastructure choice: wait years for permanent grid upgrades, or deploy mobile battery systems to charge immediately.
- Agile Fleet Operators
- Prioritize speed of deployment and flexibility, favoring mobile batteries to bypass multi-year utility delays.
- Infrastructure Developers
- Focus on long-term scale and continuous throughput, arguing that permanent grid connections are the only viable endgame.
- Grid Strategists
- View mobile and fixed charging as complementary tools to manage peak loads and stabilize local power grids.
- 1 MW
- Mobile BESS output (CSI, Komatsu)
- 3.75 MW
- CharIN MCS standard maximum
- 12–24 months
- Lead time for 20 MW grid connection
- $20M–$60M
- Cost of 100-truck public charging depot
- 30 minutes
- Time to charge Class 8 truck (10-80%)
The electrification of heavy-duty transport has hit a severe bottleneck, and it is not the vehicles themselves, but the electrical grid. A single Class 8 electric semi-truck draws as much power during a fast-charge session as a big-box retail store. Consequently, a logistics depot serving 50 to 100 trucks simultaneously requires 20 megawatts or more of dedicated grid connection—equivalent to the power draw of a small industrial town. For fleet operators, this translates to a massive logistical and financial hurdle that threatens to stall the rollout of zero-emission freight corridors. The vehicles are ready to deploy, with manufacturers ramping up production of heavy-duty electric chassis, but the concrete, copper, and utility approvals required to power them are lagging far behind.[4]
To solve the vehicle-side equation, the automotive and energy industries developed the Megawatt Charging System (MCS). By 2026, the MCS has become the globally recognized standard for heavy-duty vehicle charging, designed to deliver up to 3.75 megawatts of power through a single, specialized liquid-cooled connector. This represents a monumental leap in energy transfer, pushing nearly ten times the capacity of the fastest passenger vehicle chargers available just a few years ago. The standard ensures that trucks from different manufacturers can utilize the same high-velocity energy networks across major freight routes.[5]
At these extreme power levels, an MCS station can provide a 10 percent to 80 percent charge to a massive 600 to 800 kilowatt-hour battery pack in less than 30 minutes. This specific timeframe is critical, as it perfectly aligns with federally mandated driver rest periods. A driver can pull into a depot, connect the liquid-cooled robotic arm, take their required break, and return to a fully replenished truck. This operational parity with diesel refueling is what makes long-haul electric transport commercially viable.[5]

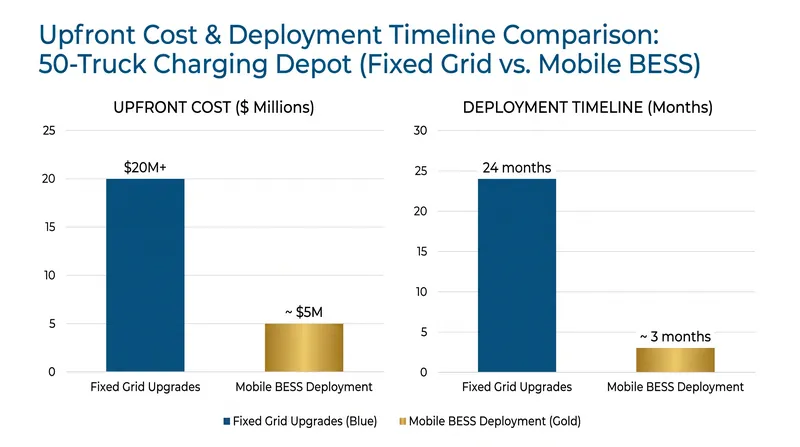

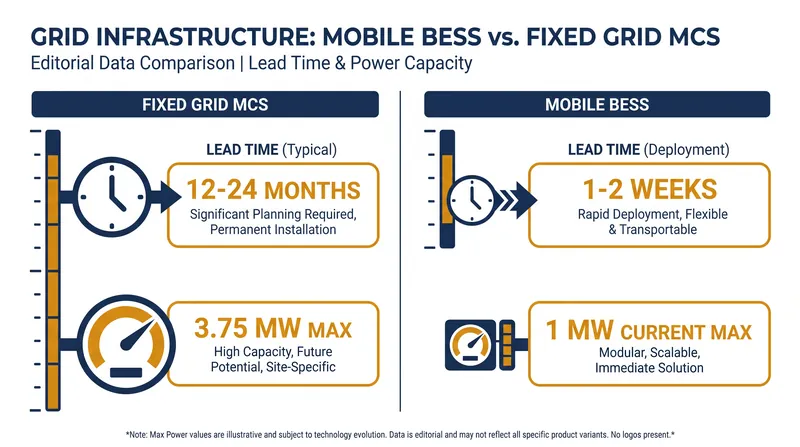

But installing fixed MCS infrastructure is brutally slow and capital-intensive. Securing a 20-megawatt grid connection requires extensive utility transformer and switchgear upgrades that carry lead times of 12 to 24 months, assuming the local utility even has the upstream capacity to grant the request. Furthermore, a large public truck charging station can cost between $20 million and $60 million depending on the scale of the site and the necessary civil engineering works. For many logistics operators, waiting two years for a utility company to trench new high-voltage lines is simply not an option when they have multi-million dollar fleets of electric trucks arriving next month. The friction of fixed infrastructure is currently the single largest barrier to heavy-duty electrification.[4]
Enter the mobile Battery Energy Storage System (BESS), a technology that bypasses the grid bottleneck entirely. In August 2026, Coulomb Solutions Inc. (CSI) announced it is adding bidirectional Megawatt Charging System capability to its newest-generation mobile BESS units. This development marks a significant shift in how fleet managers can approach high-power charging, moving the infrastructure from a fixed real estate asset to a deployable piece of equipment that can be positioned exactly where the demand is highest.[1][2]
Enter the mobile Battery Energy Storage System (BESS), a technology that bypasses the grid bottleneck entirely.
The flagship 2.3 megawatt-hour mobile model is rated for up to 1 megawatt of MCS power on both the recharging input and the charging output. This symmetrical architecture allows the mobile battery system to be rapidly recharged over an MCS connection and then redeployed in the field to deliver high-power charging directly to compatible commercial electric vehicles, such as the Tesla Semi. A smaller 699 kilowatt-hour unit carries a 700-kilowatt rating, providing a more compact option for constrained sites.[1][2]

This agile approach follows similar debuts in the off-road and heavy machinery sector. Komatsu and Dimaag recently showcased a Mobile Megawatt Charging System capable of delivering 1 megawatt of power to electric construction equipment. The rugged, four-wheel-drive unit is designed to navigate challenging, unpaved terrains and can recharge heavy machinery in just 15 minutes during operator breaks. By bringing the charger to the vehicle rather than forcing the vehicle to return to a central hub, operators eliminate costly transit downtime.[3]
These mobile units effectively act as massive, transportable power banks that decouple vehicle charging from real-time grid constraints. They can trickle-charge from a standard 480-volt AC connection overnight—when electricity is cheaper and grid demand is low—and then dump a megawatt of DC power into a truck during the day. This bidirectional capability also allows the batteries to support building loads or shave peak demand charges when they are not actively charging vehicles, turning a sunk cost into a dynamic energy asset.[2]
The economics of this battery-buffered approach fundamentally change fleet planning timelines. Instead of waiting up to two years for a utility to upgrade a local substation, a logistics operator can drop a mobile BESS on site in a matter of weeks. This allows companies to accelerate their electrification mandates, deploy their newly purchased electric trucks immediately, and begin capturing operational savings without waiting for permanent civil engineering projects to clear local zoning boards.[6]
However, mobile BESS is not a permanent substitute for raw grid capacity at a massive scale. A 2.3 megawatt-hour battery can only dispense two full megawatt-level charges to a Class 8 truck before its own reserves are depleted and it needs to be recharged. For a depot processing fifty trucks a day, relying solely on mobile batteries would require a constant, logistical ballet of swapping and recharging the BESS units themselves, which quickly becomes inefficient compared to a hardwired grid connection. Mobile units solve the problem of time and peak demand, but they cannot magically generate energy; they merely shift when and how it is drawn from the grid.[1][7]
This dynamic creates a strategic fork in the road for fleet operators. They must weigh the massive capital expenditure and multi-year delays of permanent, high-capacity grid connections against the agility and immediate deployment of battery-buffered mobile units. As the heavy-duty transport sector scales, the most successful logistics networks will likely employ a hybrid approach: anchoring their main hubs with fixed megawatt infrastructure while using mobile BESS units to rapidly spin up new routes and bridge utility delays.[7]
Key points
- The Megawatt Charging System (MCS) standard enables Class 8 trucks to charge in under 30 minutes, but fixed grid upgrades take 12 to 24 months.
- Mobile Battery Energy Storage Systems (BESS) bypass utility delays by storing energy overnight and delivering 1-megawatt fast-charging on demand.
- Coulomb Solutions and Komatsu recently debuted 1-megawatt mobile chargers, allowing fleets to deploy electric trucks in weeks rather than years.
- While mobile units offer unmatched agility, permanent fixed infrastructure remains necessary for high-throughput depots serving dozens of trucks daily.
Viewpoints in depth
The Case for Mobile BESS (Agility and Speed)
Deploying battery-buffered mobile chargers to bypass utility delays and enable immediate fleet electrification.
Mobile BESS units, such as CSI's 2.3 MWh system or Komatsu's 1 MW off-road charger, offer a critical advantage: time. A traditional 20 MW grid upgrade takes 12 to 24 months and requires extensive civil engineering. In contrast, a mobile BESS can be deployed in weeks. These systems can trickle-charge from existing 480-volt infrastructure overnight and deliver 1 megawatt of DC fast-charging during the day. This approach fits perfectly for leased depots, temporary construction sites, or logistics hubs bridging the gap while waiting for permanent utility upgrades. However, it does not fit high-throughput corridors where dozens of trucks need continuous back-to-back charging, as the mobile battery itself depletes after two or three full Class 8 charges.
The Case for Fixed Grid MCS (Scale and Throughput)
Investing in permanent, multi-megawatt grid connections for high-volume, continuous heavy-duty charging.
Fixed Megawatt Charging Systems represent the endgame for heavy-duty logistics. Built to the CharIN 3.75 MW standard, these stations can continuously charge Class 8 trucks from 10% to 80% in under 30 minutes without ever running out of stored energy. While the upfront capital expenditure is massive—ranging from $20 million to $60 million for a 100-truck public depot—the long-term economics win out at scale. Fixed infrastructure amortizes over 20 years and delivers the lowest per-kWh energy cost by drawing directly from high-voltage transmission lines. This model fits well for fleet owners who own their real estate and operate massive, centralized hubs. It does not fit agile operators, short-term leases, or sites facing multi-year utility transformer backlogs.
The Hybrid Verdict
Blending mobile agility with permanent scale to optimize total cost of ownership.
In practice, the most resilient logistics networks will not choose just one. A hybrid approach uses mobile BESS units to rapidly spin up new routes, test site viability, and bridge the 24-month gap while permanent grid connections are built. Once the fixed MCS infrastructure comes online, the mobile units can be relocated to the next expansion site or kept on hand to shave peak demand charges during high-tariff hours. This strategy fits well when operators need to scale immediately but still plan to own their long-term infrastructure.
Why this matters
For logistics companies and fleet operators, the transition to electric heavy-duty trucks is currently bottlenecked by multi-year utility delays. Choosing between permanent grid upgrades and mobile battery systems determines whether a fleet can electrify this year or in 2028.
