Explainer: How the World's First Artificial Energy Island is Rewriting Europe's Power Grid
Rising 45 kilometers off the Belgian coast, Princess Elisabeth Island is a pioneering concrete hub designed to channel 3.5 gigawatts of offshore wind and link multiple European nations into a single super-grid.
Share this story
Forty-five kilometers off the coast of Ostend, Belgium, a massive concrete fortress is rising from the cold waters of the North Sea. This is not an oil rig or a military outpost, but Princess Elisabeth Island—the world’s first artificial energy island. As of June 2026, marine engineering crews have successfully installed 17 of the 23 colossal concrete caissons that will form the island's outer ring. When completed, this five-hectare structure will serve as the beating heart of Europe's next-generation offshore power grid.[1][2][3]
The project, spearheaded by the Belgian transmission system operator Elia Group, represents a radical shift in how nations harvest renewable energy. Historically, offshore wind farms have relied on a "point-to-point" model, where each individual wind project runs its own dedicated subsea cable back to the mainland. While effective for early wind farms, this approach is rapidly becoming unsustainable as Europe scales up its offshore ambitions.[3]

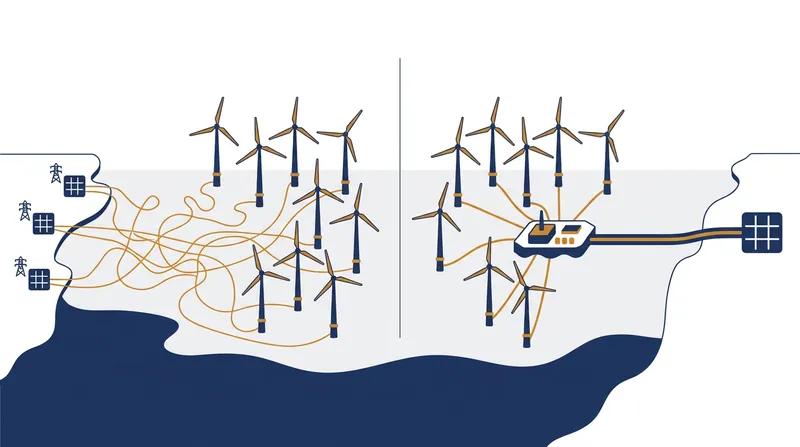

If every planned turbine required its own cable, the North Sea seabed would become a tangled, unmanageable web, and coastal electrical grids would be overwhelmed by the sheer number of landing points. Princess Elisabeth Island solves this by acting as a massive offshore socket. Up to 3.5 gigawatts of future offshore wind capacity from the surrounding Princess Elisabeth Zone will plug directly into the island, which will then bundle the electricity and send it to shore via a streamlined set of high-capacity cables.[2][3]
Building an island in one of the world's busiest shipping lanes is an unprecedented engineering challenge. The consortium TM Edison—a joint venture between marine construction giants DEME and Jan De Nul—opted for a caisson-based design rather than a traditional steel jacket platform. Steel platforms are simply not large or stable enough to house the massive electrical infrastructure required for a hub of this scale.[1][2]

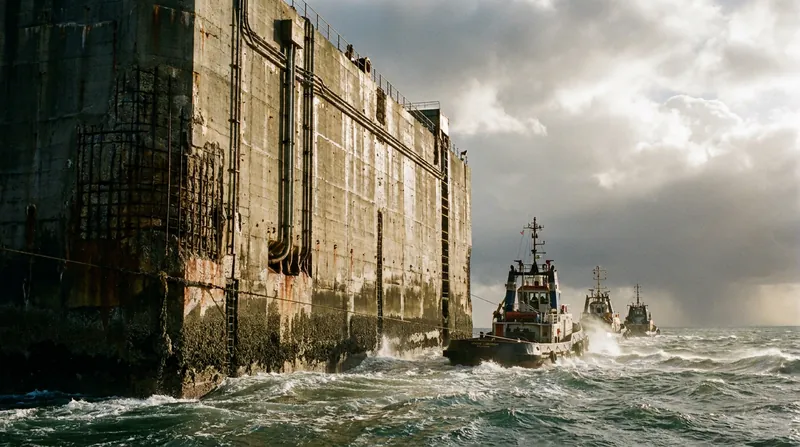

The construction process is a feat of heavy logistics. Each of the 23 concrete caissons weighs approximately 22,000 tonnes and measures 58 meters long by up to 32 meters high. Built on land using low-carbon cement, they are towed out to sea by tugboats and carefully sunk onto a prepared rock foundation on the seabed. Once the outer ring is closed, dredging vessels will fill the hollow core with sand to create a stable, solid landmass.[1][2][3]
With the foundation nearing completion in 2026, the next phase involves transforming the sandbank into a high-tech electrical nerve center. Elia Group will install advanced transformers and converters on the island. Because the island sits so far offshore, the alternating current (AC) generated by the wind turbines must be converted into high-voltage direct current (HVDC). HVDC technology allows electricity to travel vast distances underwater with minimal power loss, a crucial requirement for the island's secondary, and perhaps most important, function.[2]

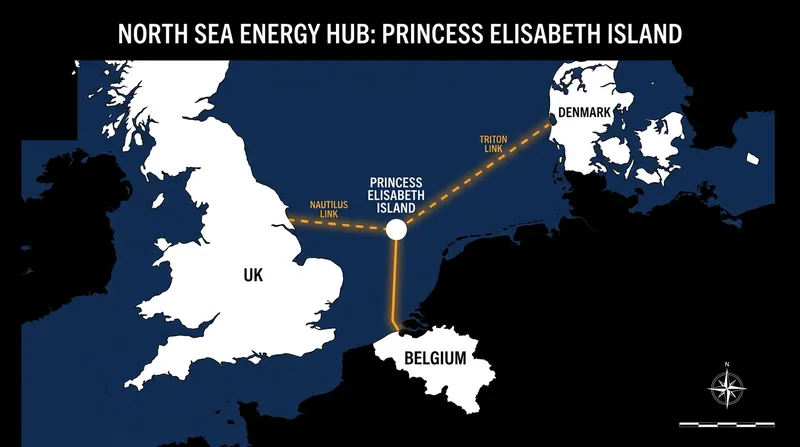

Princess Elisabeth Island is designed to be a borderless energy hub. Beyond connecting Belgian wind farms to the Belgian mainland, the island will serve as a landing point for "hybrid interconnectors" linking to other nations. Specifically, the hub will connect to the United Kingdom via the Nautilus link and to Denmark via the Triton link.[2][3]
This interconnectivity fundamentally changes the economics of offshore wind. In a traditional setup, if the wind is blowing fiercely in the North Sea but Belgian energy demand is low, the turbines might have to be curtailed—essentially turned off to avoid overloading the grid. With the island's interconnectors, that surplus green electricity can be instantly exported to London or Copenhagen, ensuring that every gust of wind is monetized and utilized.[2]

The Belgian initiative is the first physical manifestation of a much larger geopolitical strategy. Following the energy crisis triggered by Russia's invasion of Ukraine, European nations accelerated their push for energy independence. In 2022, the Esbjerg Declaration saw Belgium, Denmark, Germany, and the Netherlands commit to quadrupling their combined offshore wind capacity to 120 gigawatts by 2030, and 300 gigawatts by 2050.
Denmark is already advancing its own parallel projects to meet these targets. The Danish government plans to build an artificial energy island called Vindø in the North Sea, as well as a major energy hub on the natural Baltic Sea island of Bornholm. The bilateral agreements signed between Copenhagen and Brussels ensure that the Danish and Belgian islands will eventually communicate, forming the backbone of a meshed European super-grid.
Despite the engineering triumphs, the €2 billion Princess Elisabeth project faces logistical and economic headwinds. Supply chain bottlenecks and inflation have driven up the costs of offshore wind development globally. In a move that highlighted these pressures, the Belgian government decided to postpone the tender process for the wind farms in the Princess Elisabeth Zone until 2026.[3]
This delay means that while the island's physical construction is on track to finish its current phase, the actual wind turbines that will power it may lag behind. Energy economists note that synchronizing the completion of the island, the mainland grid upgrades, and the private wind farm deployments will require meticulous coordination to avoid having a multi-billion-euro asset sitting idle in the North Sea.
Environmental impact is another critical consideration for a project of this scale. While the island permanently alters a section of the seabed, the developers have integrated "nature-inclusive" designs into the architecture. The scour protection—the rocks placed around the base of the caissons to prevent erosion—is specifically engineered to act as an artificial reef, providing a habitat for marine life and fostering biodiversity in the heavily industrialized North Sea.[2][3]
The island is designed with a 100-year operational lifespan, far outlasting the 25-year lifecycle of a typical wind turbine. Because it is an artificial landmass rather than a rusting steel frame, it can be continuously upgraded with new electrical infrastructure as technology evolves. Jan De Nul has noted that while the caissons can theoretically be dismantled at the end of their life, future research will determine whether leaving the established artificial reef intact is the better ecological choice.[2]
As the final caissons are towed into place this summer, Princess Elisabeth Island stands as a monument to Europe's energy transition. It proves that the future of renewable energy lies not just in building more turbines, but in engineering the collaborative, cross-border infrastructure required to share that power efficiently across a continent.[1][3]
Key points
- Belgium is building the world's first artificial energy island 45 kilometers off its coast.
- The 5-hectare island will act as a central hub for 3.5 gigawatts of offshore wind energy.
- It replaces the traditional model of running individual cables from every wind farm to the shore.
- The island will feature interconnectors linking Belgium's grid to the UK and Denmark.
Unanswered questions
- Whether the delayed wind farm tenders will result in the island sitting idle before turbines are fully operational.
- The exact final cost of the project, given ongoing supply chain inflation in the offshore wind sector.
- How the artificial reef created by the island's scour protection will evolve over its 100-year lifespan.
How we got here
2021
Belgium and Denmark sign a memorandum of agreement to connect their grids via North Sea energy islands.
2022
The Esbjerg Declaration is signed, committing North Sea nations to massive offshore wind expansion.
2024
Construction of the massive concrete caissons begins on land.
2025
The first installation campaign successfully sinks caissons into the North Sea seabed.
June 2026
17 of the 23 caissons are installed, marking the final phases of the island's foundational ring.
2030
Expected completion of the island's full electrical buildout and international interconnectors.
- European Grid Operators
- Argue that meshed offshore grids are the only cost-effective way to scale renewable energy without overwhelming coastal infrastructure.
- Offshore Engineering Industry
- View the project as a pioneering technical milestone that proves the viability of massive artificial structures in harsh marine environments.
- Energy Economists & Policy Analysts
- Highlight the financial risks and coordination challenges of synchronizing a multi-billion-euro hub with private wind farm deployments.
