DOE Cancels Three National Transmission Corridors Amid Debate Over Grid Expansion and Local Control
The U.S. Department of Energy has halted the designation of three federal transmission corridors, pivoting away from greenfield grid expansion in favor of upgrading existing infrastructure.
By Hunter Cole

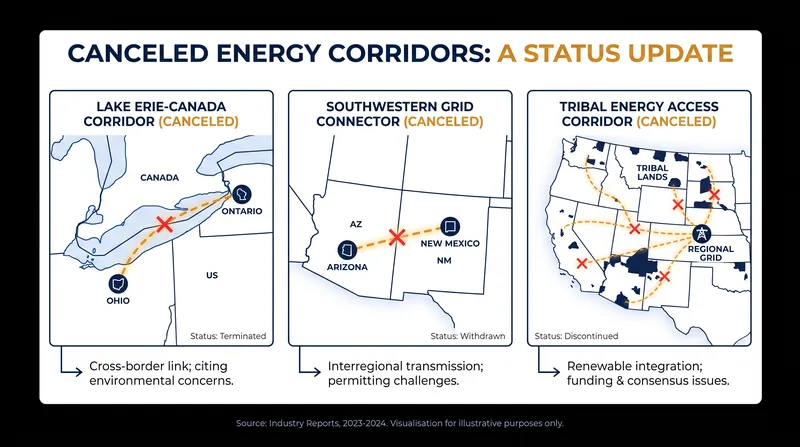

On August 12, 2026, the U.S. Department of Energy formally abandoned the designation of three National Interest Electric Transmission Corridors (NIETCs), halting a federal effort to accelerate high-voltage power lines across state borders. The canceled routes included the Lake Erie-Canada Corridor, the Southwestern Grid Connector, and the Tribal Energy Access Corridor.
The decision highlights a fundamental tension in U.S. infrastructure: the mathematical need for a larger electrical grid versus the political reality of local land use. Energy Secretary Chris Wright stated that the corridor framework proved ineffective, arguing that transmission policy should not serve a "climate-alarmist agenda that drives up costs, worsens reliability, and disregards the concerns of local communities."[1][2][4]

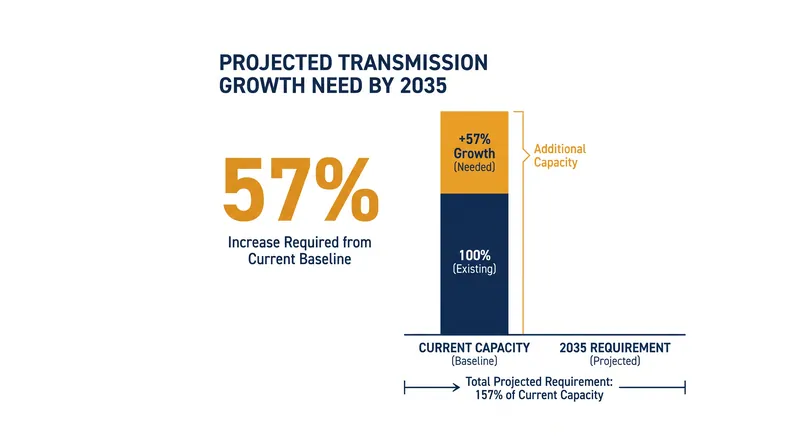

To understand the stakes, the evidence points to a looming physical bottleneck. In late 2023, the DOE's National Transmission Needs Study concluded that the U.S. electric grid requires a median 57% expansion in transmission infrastructure by 2035 to meet growing power demand, integrate new energy sources, and maintain reliability during extreme weather. The study found that the highest-value investments are interregional lines—massive wires connecting different parts of the country, such as linking Texas to the Southwest or the Plains.[5][7]
However, the construction of new high-voltage transmission has slowed significantly over the past decade, creating a widening gap between projected needs and actual deployment. While annual utility spending on transmission has reached an all-time high of roughly $25 billion, approximately 90% of those funds are directed toward replacing aging equipment and localized reliability upgrades rather than building new interregional pathways.
The NIETC program, originally established by the Energy Policy Act of 2005 and updated by recent infrastructure legislation, was designed as a federal backstop to break this exact logjam. If a region was designated as a NIETC, it unlocked federal financing tools and gave developers the ability to obtain right-of-way through eminent domain if state regulators stalled the permits.[6][7][8]
That specific threat of federal eminent domain made the transmission corridors politically radioactive almost immediately upon their proposal. Landowner advocacy groups and local politicians strongly opposed the designations, arguing that top-down federal routing bypassed local priorities and created deep, paralyzing uncertainty for agricultural operations and tribal lands.
Rep. Lauren Boebert, whose Colorado district sat within the proposed Southwestern Grid Connector, celebrated the cancellation of the corridors. She stated that federal processes were creating "more uncertainty than progress" for American families and businesses, and argued that the grid should be strengthened without overriding the concerns of the communities hosting the infrastructure.[2][6]
The Tribal Energy Access Corridor faced a particularly complex reception and carried unique stakes for the regions it touched. Originally proposed to connect multiple reservations—including the Pine Ridge and Rosebud reservations spanning parts of Nebraska and the Dakotas—with high-voltage lines, the project aimed to expand electricity access and reliability in historically underserved areas.
Its cancellation removes a dedicated federal pathway for that specific regional upgrade, leaving local utilities and tribal governments to navigate the standard, often slower, state-level permitting processes to improve their grid connections. For developers eyeing those routes, the loss of federal backing means a return to a fragmented regulatory landscape.[3]
Grid analysts view the reversal as a symptom of a structural policy failure that transcends any single administration. Rob Gramlich, president of Grid Strategies LLC and a prominent voice in transmission policy, noted that the cancellation "reinforces how dysfunctional the whole NIETC construct is."
He pointed out that having the Department of Energy make sweeping corridor designations that simply get reversed with each new administration prevents the long-term certainty required to build infrastructure projects. Because major interregional power lines routinely take a decade or more to plan, permit, and construct, developers are highly reluctant to commit capital to routes that rely on shifting political winds.[2][8]
Without the NIETC designations to force new routes, the federal government is pivoting its strategy away from greenfield expansion and toward maximizing existing physical footprints. The Department of Energy indicated it will focus heavily on financing upgrades to current infrastructure, pointing to a recent $1.6 billion loan guarantee designed to reconductor and rebuild nearly 5,000 miles of existing transmission lines across five states.
By swapping older wires for advanced, higher-capacity conductors on existing towers, grid operators can push significantly more power through the system without the need to acquire new land, navigate fresh environmental reviews, or trigger eminent domain battles with local landowners.[1]
Yet the underlying physical challenge remains unresolved, leaving a stark gap between projected demand and available capacity. As electricity demand surges from hyperscale data centers, a renaissance in domestic manufacturing, and widespread electrification, the grid must expand its sheer capacity to move power from where it is generated to where it is consumed.
The data suggests that while upgrading existing lines is a necessary and highly efficient first step, it may not be mathematically sufficient to bridge the 57% capacity gap identified in the 2023 Needs Study. Ultimately, the tension between the national imperative for a larger grid and the local resistance to hosting it will continue to dictate the pace of American infrastructure development.[5][7]
Key points
- The Department of Energy canceled three proposed National Interest Electric Transmission Corridors, halting a federal push for greenfield grid expansion.
- The canceled routes included the Lake Erie-Canada Corridor, the Southwestern Grid Connector, and the Tribal Energy Access Corridor.
- Energy Secretary Chris Wright cited local community concerns, costs, and a shift away from "climate-alarmist" policies as reasons for the cancellation.
- A 2023 DOE study found the U.S. needs a 57% increase in transmission capacity by 2035 to meet surging demand and ensure reliability.
Unanswered questions
- How the U.S. will achieve the projected 57% increase in transmission capacity by 2035 without federal siting authority.
- Whether alternative approaches, such as reconductoring existing lines, can sufficiently offset the lack of new interregional corridors.
- How the cancellation will impact the specific regions—such as the Pine Ridge and Rosebud reservations—that were slated for infrastructure upgrades.
How we got here
Aug 2005
The Energy Policy Act establishes the NIETC concept to address grid congestion.
Oct 2023
The DOE releases the National Transmission Needs Study, projecting a 57% required growth in grid capacity by 2035.
May 2024
The DOE releases a preliminary list of 10 potential national transmission corridors.
Dec 2024
The DOE narrows the list to three corridors (Lake Erie, Southwestern, Tribal Energy) to advance to Phase 3.
Aug 2026
Energy Secretary Chris Wright cancels the three corridors, citing local opposition and policy shifts.
