FERC Fast-Tracks Three Major Gas Pipelines to Boost LNG Export and Power Capacity
The Federal Energy Regulatory Commission has accelerated the approval process for three major natural gas pipeline projects across the Gulf Coast and Southeast, compressing environmental reviews to alleviate regional grid bottlenecks.
Share this story
The U.S. natural gas grid is facing an unprecedented bottleneck as liquefied natural gas (LNG) export terminals and power-hungry data centers demand more capacity than existing lines can deliver. In response, the Federal Energy Regulatory Commission (FERC) has accelerated the approval process for three major pipeline projects across the Gulf Coast and Southeast.

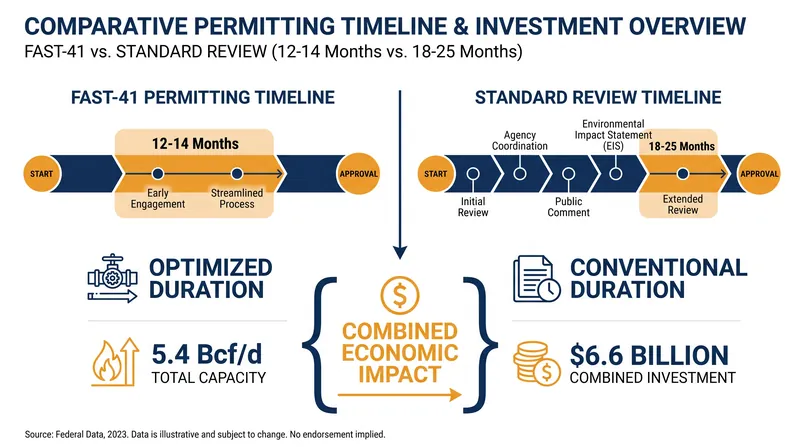

The regulatory shift utilizes the FAST-41 permitting program, a federal initiative designed to compress the typical 18-to-25-month environmental review down to just 12 to 14 months. This expedited pathway has now cleared the way for Gulf South's Texas Gateway, Kinder Morgan's system expansions, and the Mountain Valley Pipeline (MVP) Southgate extension, signaling a decisive pivot toward prioritizing infrastructure deployment over protracted regulatory scrutiny.[1]
The urgency driving FERC's expedited approvals stems from severe congestion in the nation's most prolific shale basins. In the Permian Basin, a chronic lack of takeaway capacity pushed spot prices at the Waha Hub below zero for a record 89 consecutive days earlier this year.
Without new pipelines to move the gas to market, producers are forced to flare excess output or curtail drilling operations. By fast-tracking projects that link these basins to high-demand coastal hubs, federal regulators aim to alleviate these persistent bottlenecks, stabilize regional basis differentials, and ensure a reliable feed gas supply for the next wave of LNG export facilities coming online.[1]
Gulf South's $1.4 billion Texas Gateway Project is the largest of the newly fast-tracked Gulf Coast initiatives. The 155-mile pipeline will connect the Carthage and Katy hubs in Texas to the Gillis area in Louisiana, adding 1.45 billion cubic feet per day (Bcf/d) of capacity.
The project is specifically designed to feed LNG export terminals and industrial facilities along the coast, with a targeted in-service date of late 2028. By reversing flows on existing lines and laying new 42-inch pipe, the project aims to link East Texas gas supplies directly to the heavy industrial demand centers that have increasingly strained the regional grid.
In the Southeast, Kinder Morgan is advancing two multibillion-dollar expansions to relieve severe regional constraints. The $3.5 billion South System Expansion 4 (SSE4) will add 279 miles of looping to the Southern Natural Gas system, while the $1.7 billion Mississippi Crossing (MSX) project will lay 206 miles of new pipe from Mississippi to Alabama.
Together, these projects will boost eastbound flows by up to 3.4 Bcf/d, supplying power generators in Alabama, Georgia, and South Carolina. The expansions target a corridor that has struggled to keep pace with the massive draw from Gulf Coast LNG facilities, which frequently pull gas south before it can reach Eastern utilities.[1]
The third project to receive the green light is the MVP Southgate Amendment Project. Following a decade of permitting battles and a recent redesign, FERC authorized construction on the 31.3-mile extension from Virginia into North Carolina. The revised 30-inch diameter pipeline will deliver 550 million cubic feet per day to Duke Energy and Public Service Company of North Carolina.
The authorization comes after a federal court rejected environmental groups' challenges to state-issued water quality permits, allowing the developers to finally break ground on a project that had become a flashpoint in the national debate over fossil fuel infrastructure.
The mechanics of the FAST-41 program represent a fundamental shift in how the federal government handles large-scale energy infrastructure. Created to improve the timeliness and predictability of federal environmental reviews, the program establishes a coordinated schedule across multiple agencies, with FERC acting as the lead.
While it does not guarantee project approval or alter underlying environmental statutes, it forces agencies to adhere to strict deadlines and resolve interagency disputes rapidly. For capital-intensive projects like Texas Gateway and SSE4, this predictability is crucial for securing final investment decisions and locking in long-term shipper commitments.
However, the use of FAST-41 for fossil fuel infrastructure has drawn sharp criticism from environmental advocates. Organizations like the Southern Environmental Law Center argue that expediting these reviews bypasses crucial scrutiny of greenhouse gas emissions and local water quality impacts, locking in decades of fossil fuel reliance at a time when the grid should be transitioning to renewables.
Opponents contend that compressing the review timeline limits the public's ability to meaningfully participate in the process and prevents agencies from conducting the multi-season baseline studies necessary to fully understand a project's ecological footprint.[1]
The tension between rapid infrastructure deployment and rigorous environmental oversight defines the current regulatory landscape. As these three projects move toward construction, they serve as a test case for whether the U.S. can balance its surging energy demands with its climate commitments.
Market analysts note that these infrastructure upgrades are essential to enhance supply reliability during winter peaks, factors closely monitored by gas commodity traders. Ultimately, the success of the FAST-41 approach will be measured by its ability to deliver capacity without triggering a new wave of post-approval litigation that could erase the time saved during the permitting phase.[1]
Key points
- FERC has accelerated the approval process for three major natural gas pipeline projects using the FAST-41 permitting program.
- The expedited timeline compresses federal environmental reviews from the typical 18 to 25 months down to 12 to 14 months.
- Gulf South's $1.4 billion Texas Gateway Project will add 1.45 Bcf/d of capacity to connect East Texas gas to Louisiana LNG terminals.
- Kinder Morgan's SSE4 and MSX expansions will add 3.4 Bcf/d of capacity across the Southeast to supply power generators.
Open questions
- Whether the expedited FAST-41 environmental reviews will withstand inevitable legal challenges from environmental groups.
- How the influx of new pipeline capacity will impact long-term natural gas basis differentials between the Permian Basin and the Gulf Coast.
- If the compressed permitting timeline will become the new standard for all major fossil fuel infrastructure under FERC's jurisdiction.
- Infrastructure Developers
- Argue that expedited permitting is essential to meet surging LNG export and power generation demand.
- Environmental Advocates
- Contend that fast-tracking fossil fuel projects bypasses critical climate and water quality reviews.
- Energy Market Analysts
- Focus on how new capacity will alleviate regional bottlenecks and stabilize basis differentials.
Perspectives this story doesn't cover
- Local landowners along the newly approved pipeline routes
- Renewable energy developers competing for grid interconnection
Sources
[1]Open SentimentInfrastructure DevelopersFERC Expedites Approvals for Major Gas Infrastructure Projects
Read on Open Sentiment →
More in Energy
See all →Refining Economics
The 45 Gallons of Finished Product and Processing Gain That Come From a 42-Gallon Barrel of Crude Oil
7 sources
Energy Metrics
The 6,000 Cubic Feet of Natural Gas That Defines a Barrel of Oil Equivalent (BOE)
4 sources
Rock Mechanics
The Mohr-Coulomb Failure Criterion That Dictates Rock Fracture in Hydraulic Fracturing
7 sources
Flow Assurance
The Phase Diagram and Inhibitors That Prevent Methane Hydrate Formation in Subsea Pipelines
7 sources
Comments
Every angle. Every day.
Get Energy stories with full source coverage and perspective breakdowns, free every day.
