New York Enacts First-in-Nation Statewide Moratorium on New AI Data Center Construction
Governor Kathy Hochul has signed an executive order pausing state environmental permits for hyperscale data centers while regulators assess their impact on the electrical grid and local resources.
By Mateo Ramos
On one side, the artificial intelligence boom demands unprecedented computing power, driving a historic build-out of hyperscale data centers. On the other side, local communities and grid operators are watching electricity queues swell to levels that threaten to overwhelm existing infrastructure and spike utility bills.[1][2]
In New York, that tension has culminated in a first-in-the-nation policy mechanism: a statewide pause. On July 14, 2026, Governor Kathy Hochul signed Executive Order No. 62, halting discretionary environmental permits for new large-scale data centers.[3][4]

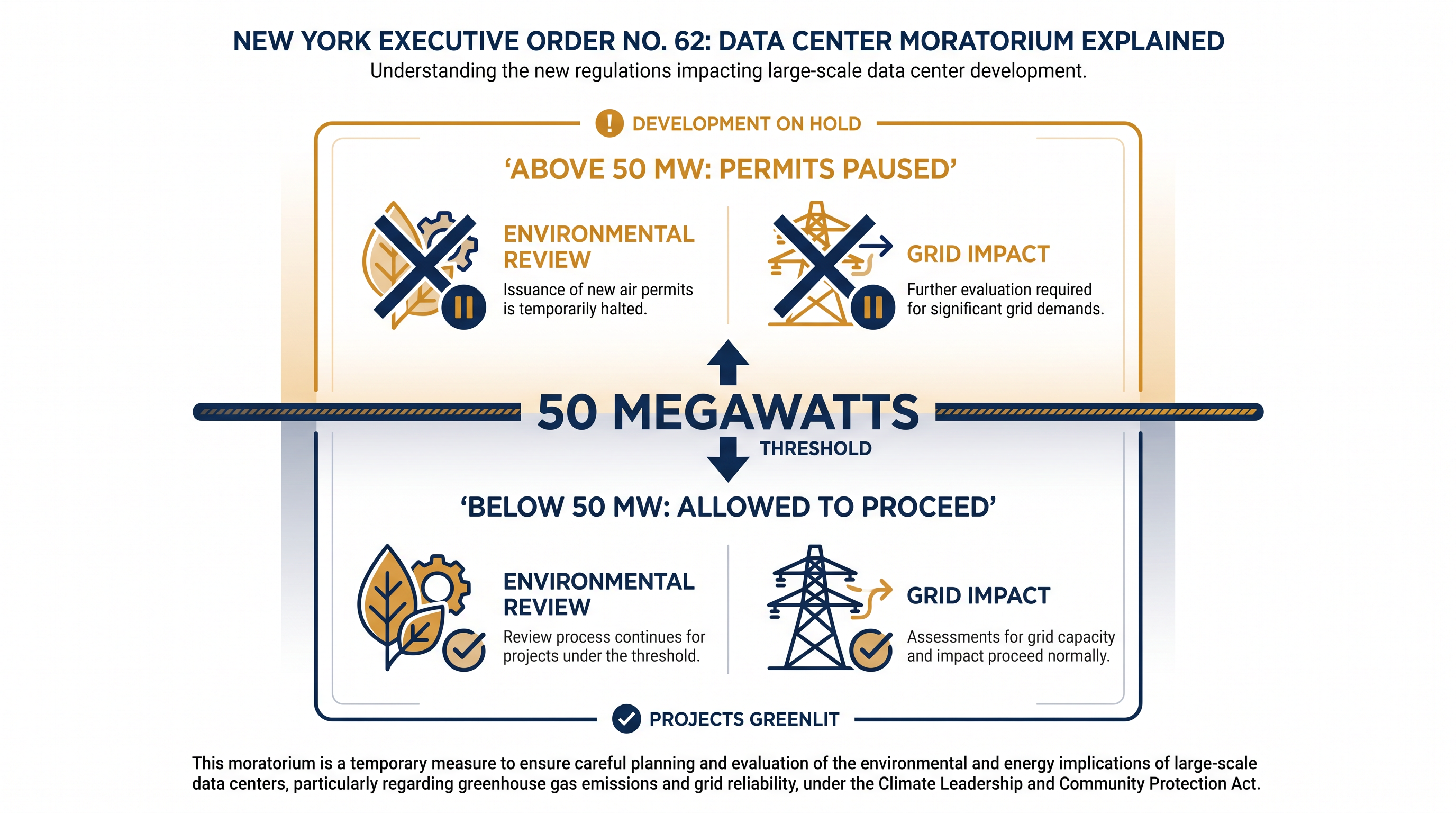

The order does not ban all data centers, nor does it override local zoning. Instead, it specifically targets the state-level environmental approvals required for facilities that consume 50 megawatts or more of electricity.[6][7]
The Department of Environmental Conservation (DEC) is instructed to hold incomplete permit applications in abeyance. Meanwhile, the Department of Public Service (DPS) will draft a Generic Environmental Impact Statement (GEIS) to establish uniform standards for how these massive facilities affect energy demand, water use, and local communities.[4][8]

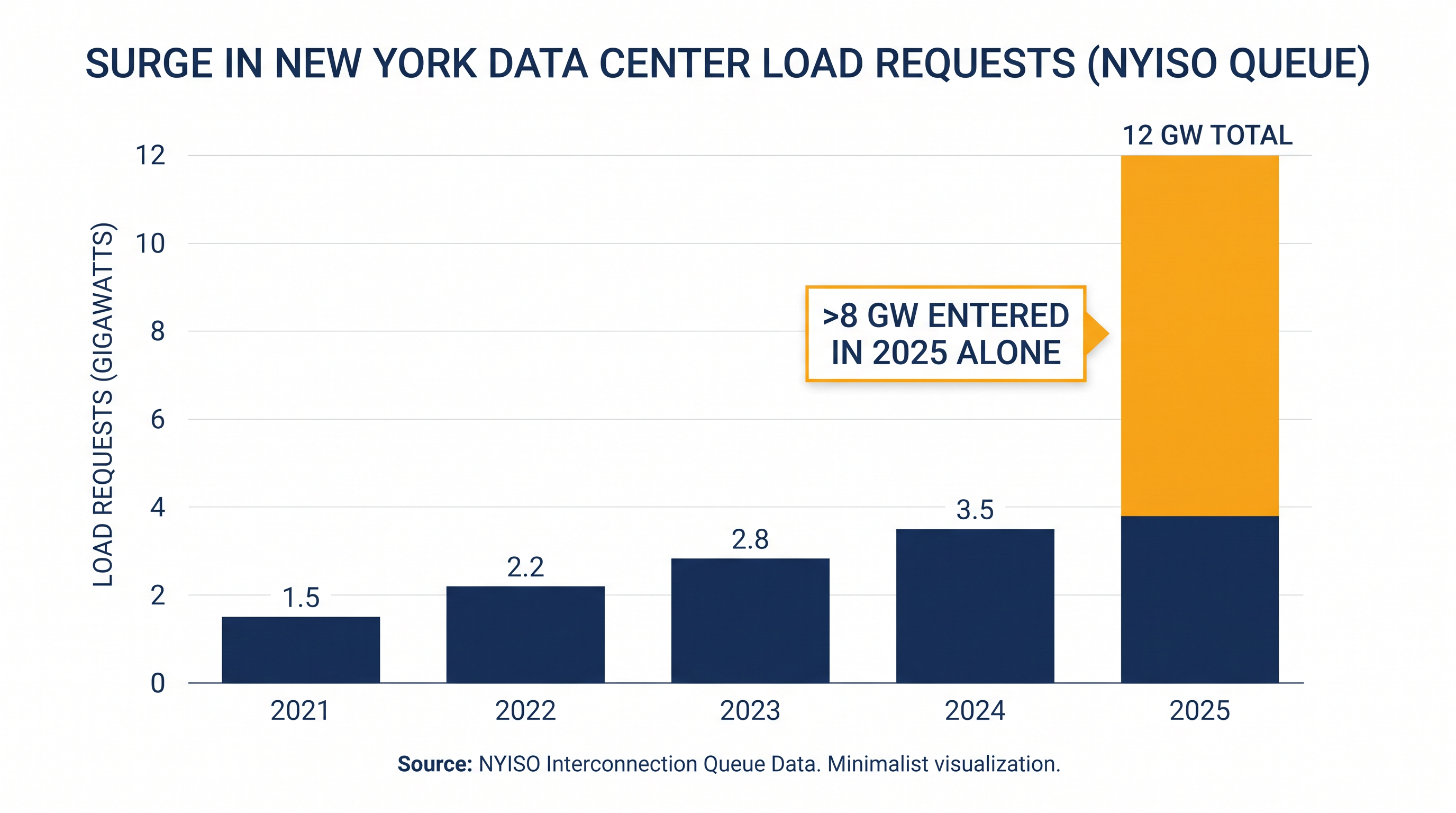

To understand why a 50-megawatt threshold matters, it helps to look at the scale of modern AI infrastructure. A single gigawatt of electricity can power roughly 750,000 homes. As of May 2026, the New York Independent System Operator (NYISO) reported nearly 12 gigawatts of data center load requests sitting in its interconnection queue.[2][6]
More than two-thirds of that capacity entered the queue in 2025 alone. If all those projects were built, they would require the energy equivalent of powering nine million households, placing extraordinary strain on transmission lines and substations.[6]
Beyond electricity, hyperscale data centers require millions of gallons of water to cool the high-density server racks that train and run large language models. The GEIS process will evaluate whether existing water withdrawal regulations adequately capture the demands of these new facilities.[1][8]
The executive order emerged from a complex legislative standoff. On June 4, the New York State Legislature passed the Responsible Data Center Development Act, a sweeping bill that would have imposed a one-year moratorium on data centers consuming just 20 megawatts or more.[2][7]
That bill included strict mandates for renewable energy usage and labor standards. Rather than signing the legislative act, Governor Hochul opted for executive action, raising the threshold to 50 megawatts and exempting applications that the DEC had already deemed complete before July 14.[6][7]
The executive order also exempts data centers primarily used for manufacturing, medical care, education, or specific research. By targeting only the largest hyperscale facilities, the state aims to freeze the most resource-intensive projects while allowing smaller enterprise data centers to proceed.[4][7]
A central focus of the pause is determining who pays for the necessary grid upgrades. Currently, the massive transmission improvements required to support gigawatt-scale loads can result in costs being shifted onto everyday residential and commercial ratepayers.[2][8]

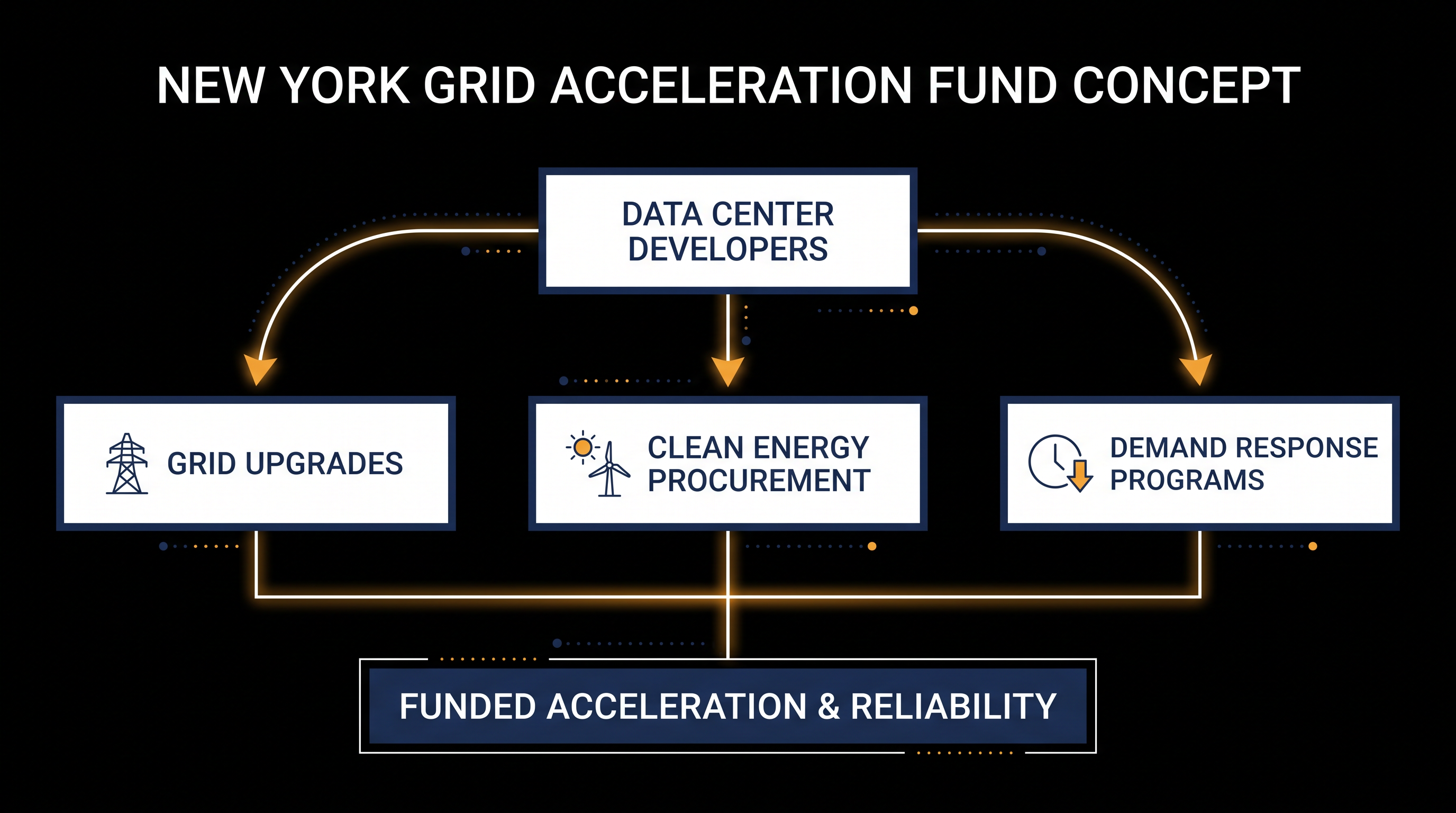

To address this, the order directs the DPS to explore a New York Grid Acceleration Fund. This mechanism could require data center developers to make upfront capital contributions, participate in demand response programs, or secure new clean energy supplies to offset their footprint.[4][8]
Additionally, the state will develop a Community Investment Framework within 60 days. This framework is designed to guide local municipalities in negotiating community benefit agreements, ensuring that host towns receive investments in infrastructure, childcare, or workforce development in exchange for housing the facilities.[2][4]
The reaction from environmental advocates has been overwhelmingly positive. Groups point out that New York residents already face high electricity rates, and shielding them from the infrastructure costs of the AI boom is a necessary consumer protection.[1][5]
Conversely, the construction and technology sectors warn of unintended economic consequences. Industry leaders argue that a blanket pause on state permits creates regulatory uncertainty that could drive billions of dollars in infrastructure investment to neighboring states with more permissive environments.[2][8]
What remains unknown is exactly how long the pause will last. While the governor's office has characterized the moratorium as lasting up to one year, the executive order itself ties the freeze to the completion of the GEIS, which has no fixed statutory deadline.[6][7]
Furthermore, because the order only pauses discretionary state environmental permits, projects that only require local municipal approvals—such as zoning or building permits—may still be able to move forward if they do not trigger DEC oversight.[6][7]
Ultimately, New York's approach represents a fundamental shift in how governments manage the physical footprint of the digital economy. By pausing to write the rules before the concrete is poured, the state is attempting to ensure that the infrastructure of the future does not compromise the resources of the present.[1][8]
Key points
- New York has enacted the nation's first statewide moratorium on new hyperscale AI data center construction.
- Executive Order No. 62 pauses discretionary state environmental permits for facilities consuming 50 megawatts or more.
- The pause will last while regulators draft a comprehensive environmental review of the industry's grid and water impacts.
- The order exempts smaller data centers, local municipal permits, and applications already deemed complete.
Unanswered questions
- Exactly how long the moratorium will last, as it is tied to the completion of an environmental review with no fixed statutory deadline.
- Whether the state legislature will attempt to override the executive order or pass additional data center restrictions in the next session.
- How many data center developers will abandon their New York projects entirely versus waiting out the regulatory pause.
How we got here
June 4, 2026
The New York State Legislature passes the Responsible Data Center Development Act, proposing a moratorium on facilities using 20 megawatts or more.
July 14, 2026
Governor Kathy Hochul signs Executive Order No. 62, establishing a 50-megawatt threshold for the permitting pause instead of signing the legislative bill.
September 12, 2026
Deadline for the Empire State Development agency to publish the Community Investment Framework for local municipalities.
- State Regulators & Consumer Advocates
- Argues that a pause is necessary to protect the electrical grid and shield ratepayers from infrastructure costs.
- Tech Industry & Developers
- Warns that regulatory uncertainty will drive AI infrastructure investment and jobs to competing states.
- Environmental Organizations
- Celebrates the pause as a crucial step to evaluate the water consumption and emissions footprint of hyperscale computing.
- Local Municipalities
- Focuses on securing community benefits and maintaining local zoning control over massive infrastructure projects.
Perspectives this story doesn't cover
- Existing New York ratepayers facing current utility bill increases
- Adjacent states competing for redirected data center investments
Sources
[1]The Washington PostLocal MunicipalitiesNew York becomes first state to block new data centers
Read on The Washington Post →
[2]Engineering News-RecordTech Industry & DevelopersNew York Imposes First Statewide Moratorium on Large Data Centers
Read on Engineering News-Record →
[3]ESG DiveEnvironmental OrganizationsNew York halts large data center construction for 1 year
Read on ESG Dive →
[4]New York State Governor's OfficeState Regulators & Consumer AdvocatesGovernor Hochul Signs Executive Order Establishing Temporary Moratorium on Data Centers
Read on New York State Governor's Office →
[5]EarthjusticeEnvironmental OrganizationsNYS Legislature Passes Data Center Moratorium
Read on Earthjustice →
[6]Foley & Lardner LLPTech Industry & DevelopersNew York Enacts First-in-Nation Statewide Moratorium on AI Data Center Development
Read on Foley & Lardner LLP →
[7]Davis Wright Tremaine LLPTech Industry & DevelopersNew York's Executive Order No. 62: A Targeted Pause on Data Center Permitting
Read on Davis Wright Tremaine LLP →
[8]Thompson Hine LLPTech Industry & DevelopersNew York Imposes Nation's First Statewide Moratorium on Hyperscale Data Centers
Read on Thompson Hine LLP →
[9]Phillips Lytle LLPTech Industry & DevelopersNew York State Issues Data Center Moratorium
Read on Phillips Lytle LLP →
More in Artificial Intelligence
See all →AI Infrastructure
Machine Traffic Surpasses Human Traffic on the Internet for the First Time at 57.4%
8 sources
AI Regulation
Senator Proposes 'Secure AI Act' Mandating NSA Access to Frontier Models 21 Days Before Release
6 sources
AI Infrastructure
Alphabet's $205 Billion AI Infrastructure Buildout Causes First Negative Cash Flow Since IPO
9 sources
AI Regulation
Colorado Repeals Landmark AI Act, Scrapping Mandatory Risk Assessments and Pre-Use Impact Reports
7 sources
Comments
Every angle. Every day.
Get Artificial Intelligence stories with full source coverage and perspective breakdowns, free every day.
