Spain Reverses Nuclear Phase-Out, Extends Almaraz Reactor Life to 2030
The Spanish government has authorized a three-year operational extension for the Almaraz nuclear power plant, delaying its planned 2027 retirement to secure grid reliability amid rising electricity demand.
- Grid Reliability Advocates
- Argues that existing nuclear plants must be maintained to ensure a stable, weather-independent electricity supply and protect consumers from fossil fuel volatility.
- Pragmatic Transition Planners
- Views the extension as a temporary, necessary measure to bridge the gap while renewable and storage infrastructure is built, without abandoning the ultimate phase-out goal.
- Accelerated Decarbonization Proponents
- Opposes the extension, arguing it stalls the transition to a fully renewable grid and represents a capitulation to corporate utility interests.
Summary
- Spain has officially extended the operating license of the Almaraz nuclear power plant until June 2030, delaying its planned 2027 retirement.
- The decision was driven by the need to secure reliable baseload power amid volatile international natural gas markets and rising electricity demand.
- The Almaraz facility supplies more than 7% of Spain's electricity and supports approximately 4,000 local jobs.
- The government insists the extension is temporary and does not alter the ultimate goal of phasing out all nuclear power by 2035.
- Industry advocates welcome the move as a necessary grid stabilization measure, while environmental groups criticize it as a delay in decarbonization.
A common misconception about national energy transitions is that nuclear phase-outs are irreversible political mandates that execute exactly on schedule. The reality is that grid physics ultimately outvote policy. When Spain announced the extension of the Almaraz nuclear plant's operational life to 2030, delaying its planned 2027 retirement, it demonstrated that baseload power cannot be retired until replacement infrastructure is fully capable of carrying the load.[5]

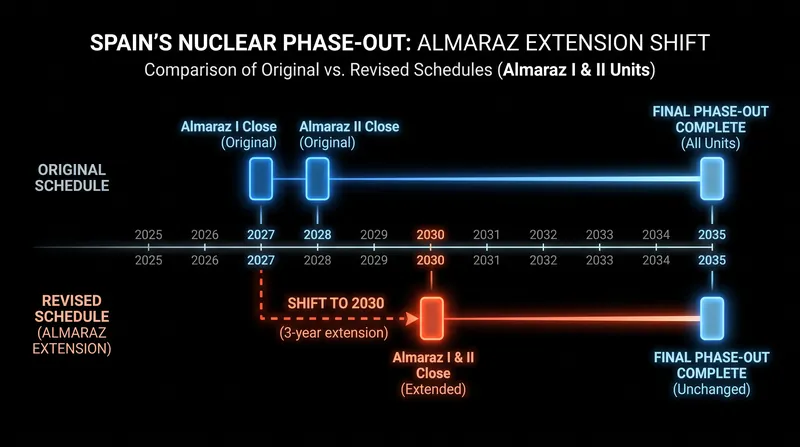

On August 14, 2026, Spain's Ministry for the Ecological Transition and the Demographic Challenge (MITECO) published Order TED/864/2026 in the Official State Gazette (BOE). The order formally grants a limited operational extension to Units I and II of the Almaraz nuclear power plant in Extremadura. Originally slated to begin decommissioning in November 2027 and October 2028, the two reactors are now authorized to generate electricity until June 8, 2030.[3]
The extension represents a significant, albeit temporary, departure from Spain's 2019 nuclear phase-out agreement. Under that framework, the government and utility operators agreed to systematically shut down all seven of the country's operating nuclear reactors between 2027 and 2035. Almaraz, Spain's oldest commercial nuclear facility, was scheduled to be the first to go offline.[4]
Almaraz is a cornerstone of the Spanish electricity grid. The facility consists of two pressurized water reactors (PWRs)—a design where water is kept under high pressure so it does not boil, transferring heat to a secondary system to drive turbines. Together, the units have a net capacity of over 2,000 megawatts, supplying more than 7% of the electricity consumed in Spain and supporting approximately 4,000 local jobs.[1][4]

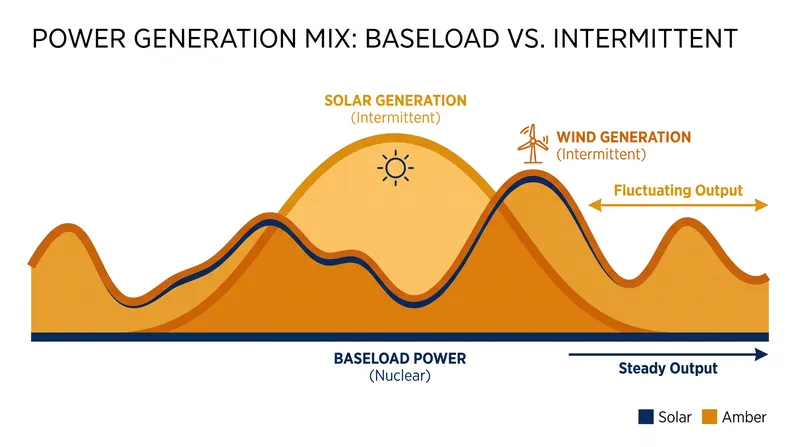

The difficulty of replacing Almaraz lies in the fundamental physics of its output. Nuclear plants provide firm, synchronous baseload capacity—meaning they generate a consistent, weather-independent supply of electricity around the clock. While Spain has rapidly expanded its solar and wind generation, those intermittent sources cannot simply be swapped one-to-one for a nuclear reactor. To replicate the 24/7 reliability of baseload power, a grid requires not just renewable generation, but massive deployments of utility-scale energy storage and robust interconnection capacity to import power when local weather conditions are unfavorable.[5]
The debate over Spain's phase-out timeline intensified following a major, multi-country blackout across the Iberian Peninsula in April 2025. The event exposed vulnerabilities in the region's energy resilience and prompted intense discussions about baseload security. Following the blackout, the plant's co-owners—Iberdrola, Endesa, and Naturgy—formally requested a three-year operating extension in October 2025.[2][4]
The debate over Spain's phase-out timeline intensified following a major, multi-country blackout across the Iberian Peninsula in April 2025.
The extension request underwent rigorous technical scrutiny by Spain's Nuclear Safety Council (CSN). In July 2026, the CSN issued a favorable report, confirming that Almaraz meets all safety and radiological protection requirements to operate safely through the new 2030 deadline. This technical clearance paved the way for MITECO's final political authorization.[1][3]
In its official order, MITECO cited severe uncertainty in international energy markets as the primary driver for the delay. The ongoing conflict in the Middle East and the war in Ukraine have introduced extreme volatility into global natural gas prices. By temporarily maintaining Almaraz's firm generation capacity, the government aims to shield Spanish consumers from unforeseen price spikes while renewable and storage infrastructure continues to scale.[1][3]
Beyond geopolitical volatility, Spain's electricity demand has evolved differently than projected when the phase-out was legislated in 2019. The rapid proliferation of hyperscale data centers—drawn to Spain's abundant solar resources and strategic location for submarine cables—alongside the accelerating adoption of electric vehicles, has created a structural surge in power consumption. This demand growth narrowed the margin for error in retiring firm capacity, forcing planners to acknowledge that the grid needs every available megawatt to support the electrification of the broader economy.[5]
MITECO has been careful to frame the decision as a limited, short-term extension rather than a reversal of its broader decarbonization strategy. The ministry explicitly stated that the 31-month and 19-month extensions for Units I and II do not alter the ultimate 2035 deadline for shutting down the entire Spanish nuclear fleet.[2][3]
The decision has exposed fractures within Spain's governing coalition. Sumar, the far-left junior partner to Prime Minister Pedro Sánchez's Socialist Workers' Party (PSOE), strongly condemned the extension. Critics argue the move is a capitulation to corporate pressure that stalls the country's transition to a fully renewable grid and undermines its 2030 climate targets.[2]
Conversely, the European nuclear industry views the Almaraz extension as a necessary correction. Nucleareurope, the Brussels-based industry association, welcomed the decision as aligning with the European Commission's recommendation to maximize the lifespan of existing nuclear assets. Industry advocates hope this pragmatic delay will force a broader reconsideration of the 2035 phase-out mandate.[1][4]
The Almaraz extension immediately raises questions about the rest of Spain's nuclear timetable. The Ascó I and Cofrentes reactors are currently scheduled to close in 2030. As those deadlines approach, the Spanish government will face the same physical grid constraints, forcing policymakers to continually weigh their phase-out ambitions against the uncompromising reality of electricity demand.[2][5]
Definitions
- Baseload Power
- The minimum level of electricity demand on a grid over a 24-hour period, typically met by power plants that can generate a consistent, uninterrupted supply of energy, such as nuclear or coal facilities.
- Pressurized Water Reactor (PWR)
- A type of nuclear reactor where water is kept under high pressure so it does not boil, transferring its heat to a secondary water system to produce the steam that drives electricity-generating turbines.
- Nuclear Safety Council (CSN)
- The independent Spanish regulatory body responsible for overseeing nuclear safety and radiological protection, which must approve any changes to a nuclear plant's operating license.
- Interconnection Capacity
- The physical infrastructure, such as high-voltage transmission lines, that allows different regional or national electricity grids to share power, helping to balance supply and demand.
Questions & answers
Why was the Almaraz nuclear plant originally scheduled to close?
Under a 2019 agreement between the Spanish government and utility operators, Spain committed to a complete phase-out of its seven nuclear reactors between 2027 and 2035 to transition to a fully renewable grid. Almaraz Units I and II were scheduled to be the first to close in 2027 and 2028.
Will the extension increase electricity costs for Spanish consumers?
According to the Ministry for the Ecological Transition (MITECO), the extension will not impose additional costs on consumers. In fact, the government argues that maintaining the plant's firm generation capacity will help protect consumers from price spikes caused by volatile international natural gas markets.
Does this decision mean Spain is abandoning its nuclear phase-out?
The Spanish government insists it is not abandoning the phase-out. MITECO framed the decision as a 'limited, short-term extension' and explicitly stated that the ultimate deadline to shut down the entire nuclear fleet by 2035 remains unchanged.
How much electricity does the Almaraz plant generate?
The two reactors at Almaraz have a combined net capacity of over 2,000 megawatts and supply more than 7% of all the electricity consumed in Spain.
Significance
Spain's decision illustrates the physical limits of rapid energy transitions. By extending the life of its oldest nuclear plant, Madrid is acknowledging that grid stability and consumer price protection must temporarily take precedence over political phase-out timelines.
Sources
[1]World Nuclear NewsGrid Reliability AdvocatesGovernment approves extended operation of Almaraz plant
Read on World Nuclear News →
[2]PV MagazineAccelerated Decarbonization ProponentsSpain extends Almaraz nuclear plant operation through 2030
Read on PV Magazine →
[3]Boletín Oficial del EstadoPragmatic Transition PlannersOrden TED/864/2026, de 12 de agosto, por la que se concede la renovación de la autorización de explotación de la Central Nuclear Almaraz, Unidades I y II
Read on Boletín Oficial del Estado →
[4]World Nuclear AssociationGrid Reliability AdvocatesNuclear Power in Spain
Read on World Nuclear Association →
[5]Factlen Editorial TeamPragmatic Transition PlannersSynthesis by Factlen editorial team
