PJM Grid Reform Unlocks 200 GW of New Power Projects in Largest US Interconnection Queue Overhaul
PJM Interconnection has advanced 715 proposed generation projects into its newly reformed study cycle, clearing a massive administrative backlog and unlocking 201.5 gigawatts of potential capacity.
By Layla Zaher
It is widely assumed that the primary bottleneck to the energy transition is a lack of willing capital or available technology. In reality, the most formidable barrier has been administrative: the bureaucratic queue to physically plug into the grid. For years, developers of solar, wind, and storage projects have found themselves trapped in a multi-year waiting room, paralyzed by a regulatory framework designed for a slower era of energy development.
Now, the evidence suggests that structural reform can break the logjam. On August 3, 2026, PJM Interconnection—the largest regional grid operator in the United States—advanced 715 proposed electricity generation projects into the first cycle of its redesigned interconnection process. By overhauling how it evaluates new power plants, PJM has effectively unlocked a staggering 201.5 gigawatts of potential generating capacity, clearing the path for a massive injection of new supply.[1][2]
The sheer scale of the capacity entering PJM’s Cycle 1 study phase underscores the pent-up demand within the energy sector. To put 201.5 gigawatts into perspective, it represents more than the entire existing generation capacity of many industrialized nations, and far exceeds PJM's current installed base.
The 715 projects that successfully navigated the initial screening process were selected from a pool of 811 applications submitted before the April 2026 deadline. By successfully launching this cohort, PJM has officially eliminated the legacy backlog that had plagued the organization for years, signaling a transition from administrative paralysis to active infrastructure deployment.[1][4]
The mechanism driving this breakthrough is a fundamental shift in regulatory philosophy, mandated in part by federal regulators to resolve a nationwide crisis. Previously, PJM operated on a "first-come, first-served" serial model. Under that old system, developers could submit speculative applications with minimal financial risk, effectively securing a place in line while they shopped around for financing, off-takers, or land.
This dynamic clogged the queue with "ghost" projects that were never likely to be built, forcing grid engineers to waste thousands of hours studying hypothetical grid impacts. The backlog became so severe that in 2022, PJM was forced to freeze new applications entirely just to process the existing pile.[6][7]

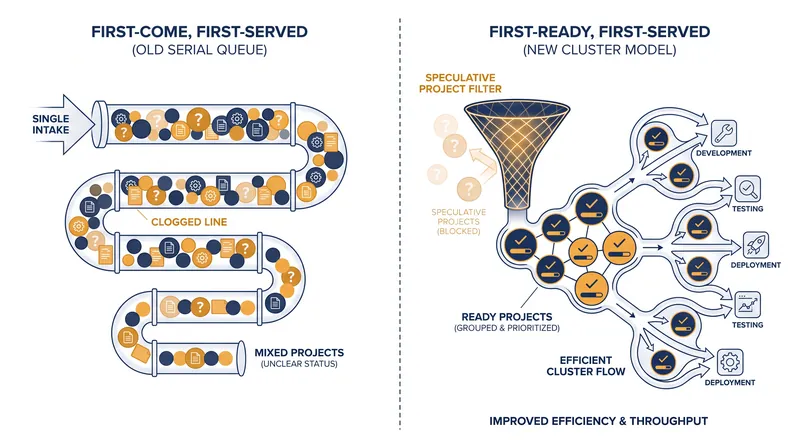

The newly implemented framework replaces that serial queue with a "first-ready, first-served" cluster-study approach. Applicants must now demonstrate concrete project viability before entering the queue by providing meaningful upfront financial deposits and definitive proof of site control. Instead of studying projects one by one, PJM groups them into regional clusters, evaluating their collective impact on the transmission network simultaneously.
This rigorous screening acts as a filter, ensuring that PJM’s engineering resources are dedicated exclusively to projects with a high probability of reaching commercial operation, while the cluster approach drastically reduces the time required to issue interconnection agreements.[1][2][5][6]

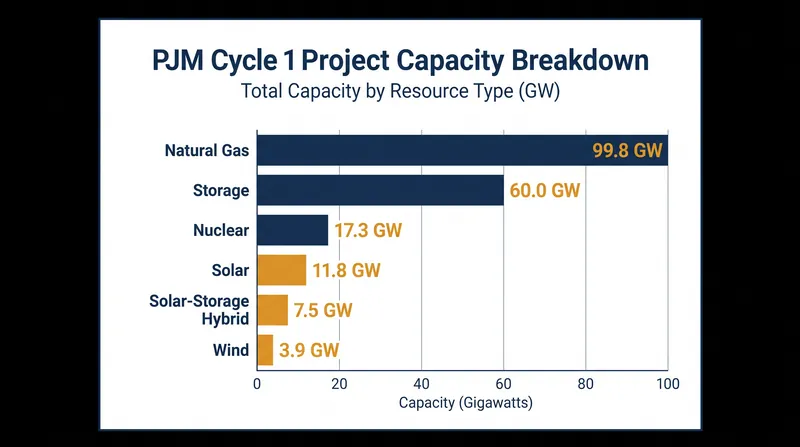

While the reform was widely championed by clean energy advocates, the actual composition of the newly unlocked capacity reflects a complex, pragmatic response to grid reliability. Natural gas accounts for the largest share of the proposed capacity, with 147 projects representing 99.8 gigawatts. However, battery storage dominates the total project count, with 314 individual applications totaling 60 gigawatts of capacity.
This divergence between capacity and project count illustrates the different roles these assets play: massive, centralized gas plants are being proposed to provide bulk baseload power, while hundreds of smaller battery installations are being distributed across the network to manage peak demand and frequency regulation.[3][5][6]
Beyond gas and storage, the Cycle 1 cohort includes a substantial wave of zero-carbon generation. The cycle features 17.3 gigawatts of nuclear power across 24 projects, reflecting a renewed industry interest in both traditional and small modular reactors. Solar development remains robust with 11.8 gigawatts across 117 projects, complemented by 7.5 gigawatts of solar-storage hybrids and 3.9 gigawatts of wind.
This diverse resource mix highlights a dual-track strategy among developers: deploying fast-responding renewables and storage to meet corporate clean energy mandates, while relying on high-capacity natural gas and nuclear facilities to provide the firm, dispatchable power required by industrial consumers.[1][3][5][6]

The urgency behind PJM’s queue overhaul is driven by an unprecedented surge in projected electricity demand. After nearly two decades of flat load growth, the mid-Atlantic and Midwest regions are facing a structural shift in consumption. PJM forecasts that regional electricity demand could increase by as much as 70 gigawatts by 2038.
This acceleration is largely fueled by the rapid proliferation of artificial intelligence data centers, advanced manufacturing facilities, and the broader electrification of the transportation sector. Because these new loads are geographically concentrated and highly power-intensive, they compress traditional development timelines, forcing grid operators to accelerate interconnection to prevent capacity shortfalls.[1][2][4][6]
To manage the sheer volume of technical data required to study 715 concurrent projects, PJM has integrated advanced software into its administrative workflow. The grid operator is utilizing HyperQ, an artificial intelligence-enabled platform developed by Google’s Tapestry, to process the massive influx of application documents.
By automating the extraction and validation of technical specifications, the AI tool allows PJM engineers to focus on complex system-impact modeling rather than manual data entry. PJM plans to evaluate the software's performance throughout the Cycle 1 study phase, with the goal of further compressing review timelines and standardizing the evaluation process across its 13-state footprint.[2][4]
Despite the administrative triumph of clearing the queue, significant hurdles remain before these 201.5 gigawatts materialize as physical infrastructure. The nameplate capacity figures represent a maximum potential output; historically, a substantial percentage of projects that enter the study phase withdraw before signing an interconnection agreement due to high network upgrade costs.
Even for those that successfully complete the one-to-two-year PJM review, developers must still navigate a labyrinth of state and local permitting requirements, secure final financing, and overcome ongoing supply chain constraints for critical components. The queue has been unblocked, but the physical buildout of the grid is only just beginning.[1][4][5]
Key points
- PJM Interconnection has advanced 715 projects representing 201.5 GW of capacity into its reformed study cycle.
- The new 'first-ready, first-served' process requires upfront financial deposits and site control to weed out speculative applications.
- Natural gas leads in total capacity at 99.8 GW, while battery storage leads in project volume with 314 applications.
- PJM forecasts regional electricity demand will increase by up to 70 GW by 2038, driven largely by data centers.
What we don’t know
- How many of the 715 projects will ultimately withdraw due to high network upgrade costs identified during the study phase.
- Whether state and local permitting timelines will delay the projects that successfully secure interconnection agreements.
- How effectively the HyperQ AI tool will compress the overall review timeline compared to legacy methods.
