The N-1 Criterion That Defines Grid Reliability Planning and Transmission Redundancy

The foundational engineering rule of the modern power grid dictates that the system must absorb the sudden loss of any single component without cascading failure.

By Aarav Khanna

Grid Reliability Planners 40%Ratepayers and Economists 30%Clean Energy Developers 30%
Grid Reliability Planners
Prioritize absolute system stability and advocate for strict enforcement of redundancy standards to prevent cascading blackouts.
Ratepayers and Economists
Focus on the financial burden of building redundant infrastructure that sits idle, pushing for more efficient grid utilization.
Clean Energy Developers
Argue that battery storage and grid-enhancing technologies can provide N-1 redundancy faster and cheaper than new transmission lines.

Perspectives this story doesn't cover

  • Industrial Load Consumers

Summary

  1. The N-1 criterion dictates that a power grid must survive the sudden loss of any single component without dropping customer load.
  2. To meet this standard, transmission lines are typically operated well below their maximum capacity to leave room for emergency power flows.
  3. The North American Electric Reliability Corporation enforces this through the TPL-001-5 standard, requiring continuous computational modeling.
  4. Grid operators are increasingly using utility-scale battery storage to provide N-1 redundancy, deferring the need for expensive new transmission lines.

Under the North American Electric Reliability Corporation's TPL-001-5 standard, a transmission planner must prove that their network can instantly lose its largest single generator or highest-capacity power line without dropping customer load. This mathematical baseline, known universally in power engineering as the N-1 criterion, dictates the physical architecture of the modern grid.[1][4][5]

The "N" in the equation represents the total number of components operating in a given electrical system—every transformer, substation, transmission tower, and spinning turbine. N-1 requires that if exactly one of those components fails without warning, the remaining infrastructure possesses enough idle capacity to absorb the redirected power flows instantly.[1][2]

When a 1,200-megawatt nuclear reactor trips offline, the physics of alternating current demand that 1,200 megawatts of replacement power materialize within milliseconds to maintain the grid's 60-hertz frequency. If the transmission lines connecting the backup generators to the load centers are already running at 100 percent capacity, the replacement power cannot flow, and the grid collapses.[3]

To prevent this, grid operators must build and maintain a shadow system of redundant capacity. A 500-kilovolt transmission corridor might only be permitted to operate at 60 percent of its thermal limit during normal conditions, holding the remaining 40 percent in reserve specifically to carry the load of a neighboring line if a tree branch causes a short circuit.[1][3]

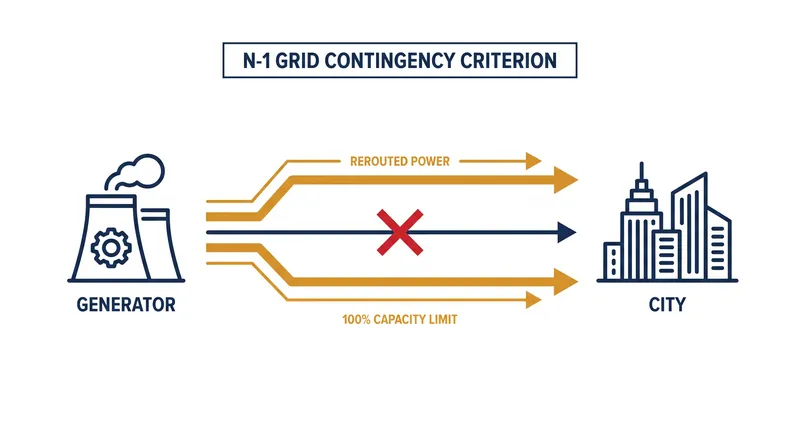

How an N-1 contingency forces power to reroute through parallel infrastructure.

The regulatory enforcement of this engineering principle in the United States is codified in the Federal Register under the 2020 approval of TPL-001-5. The Federal Energy Regulatory Commission mandates that utilities "establish Transmission System planning performance requirements" to ensure the Bulk Electric System survives a wide range of probable contingencies.[4][5]

Compliance requires continuous, computationally intensive modeling. Planners run power flow simulations that systematically remove one component at a time from a digital twin of the grid, verifying that no remaining line exceeds its thermal rating and no substation experiences a voltage collapse.[3][5]

The standard has evolved to scrutinize the hidden vulnerabilities within the safety equipment itself. As noted by TRC Companies, recent regulatory updates mean "NERC addresses single points of failure in protection systems," ensuring that a faulty relay or a stuck circuit breaker does not turn an N-1 event into a cascading blackout.[6]

The standard has evolved to scrutinize the hidden vulnerabilities within the safety equipment itself.

Preparing for these stringent compliance audits requires significant capital investment. Utilities must upgrade aging infrastructure and deploy advanced monitoring systems to satisfy the data requirements of TPL-001-5 and related protection system standards like PRC-005-6.[7]

The financial tension at the heart of the N-1 criterion is that ratepayers are funding infrastructure designed explicitly not to be used. Building a $500 million transmission line solely to serve as a backup pathway increases retail electricity rates while generating zero megawatt-hours of new energy under normal conditions.[3][7]

This cost dynamic is driving a shift toward non-wires alternatives. Instead of pouring concrete and stringing new copper, grid operators are increasingly looking to utility-scale battery storage to provide N-1 redundancy.[2]

European energy storage developers, such as Kyon Energy, highlight that battery systems can inject maximum power into the grid in under 200 milliseconds. Strategically placed batteries can artificially relieve congestion on a constrained line during an N-1 contingency, deferring the need for physical transmission upgrades.[2]

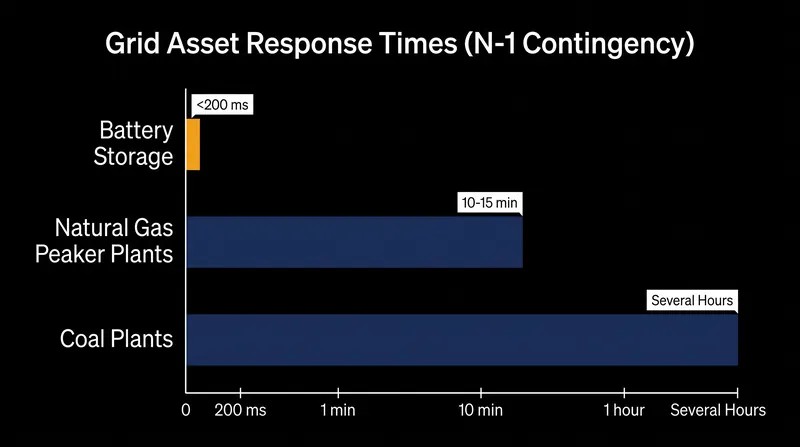

Battery storage systems can respond to grid contingencies orders of magnitude faster than thermal power plants.

However, the N-1 criterion is increasingly being tested by the realities of climate change. A standard designed around the random, isolated failure of a single component struggles to account for a wildfire or a winter storm that simultaneously takes out a dozen power plants and multiple transmission corridors.[4][5]

To address this, planners also model N-1-1 contingencies—scenarios where one component is already out of service for maintenance, and a second unexpected failure occurs. Operators typically have 30 minutes to adjust the system after the first loss to prepare for the second.[1][5]

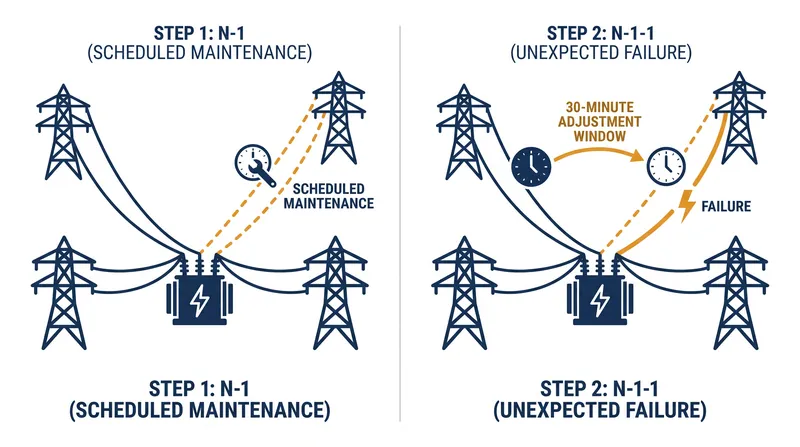

Planners must also model N-1-1 scenarios, where a second failure occurs while a component is already offline for maintenance.

As the grid transitions from large, centralized fossil fuel plants to distributed, weather-dependent renewables, the geometry of N-1 redundancy is changing. The loss of a single 10-megawatt solar farm is trivial compared to the loss of a 1,000-megawatt coal plant, but the transmission network must now manage bidirectional flows across thousands of smaller nodes.[2][3]

The ultimate constraint on grid reliability remains the physical reality of thermal limits and voltage stability. Whether enforced by federal mandates or managed by advanced grid-enhancing technologies, the requirement to survive the next unexpected failure will continue to dictate the pace and cost of the energy transition.[4][7]

1,200 megawatts
Typical large reactor capacity
60 hertz
Standard North American grid frequency
200 milliseconds
Battery N-1 response time
30 minutes
Adjustment window for N-1-1 events

Limits of the evidence

  • How extreme weather events will shift the baseline probabilities of N-2 or N-3 contingencies, where multiple components fail simultaneously.
  • Whether virtual power plants and distributed energy resources can fully replace physical transmission redundancy at a continental scale.
  • How the increasing deployment of grid-forming inverters will alter the mathematical models used to simulate N-1 voltage stability.

Sources

Source coverage

8 outlets

3 viewpoints surfaced

Grid Reliability Planners 40%Ratepayers and Economists 30%Clean Energy Developers 30%
  1. [1]eRoots Analytics

    What is N-1 Criterion?

    Read on eRoots Analytics
  2. [2]Kyon EnergyClean Energy Developers

    n-1 criterion

    Read on Kyon Energy
  3. [3]Federal Energy Regulatory CommissionGrid Reliability Planners

    TRANSMISSION PLANNING

    Read on Federal Energy Regulatory Commission
  4. [4]Federal Register

    Transmission Planning Reliability Standard TPL-001-5

    Read on Federal Register
  5. [5]NERCipediaGrid Reliability Planners

    TPL-001-5.1 — Transmission System Planning Performance Requirements

    Read on NERCipedia
  6. [6]TRC Companies

    NERC Addresses Single Points of Failure in Protection Systems Among Other FERC Concerns

    Read on TRC Companies
  7. [7]Utility DiveRatepayers and Economists

    Navigating the currents of compliance: How to prepare for NERC PRC-005-6 and TPL-001-5

    Read on Utility Dive
  8. [8]Factlen Editorial Team

    Synthesis by Factlen editorial team

    Read on Factlen Editorial Team

Comments

Stay informed

Every angle. Every day.

Get Energy stories with full source coverage and perspective breakdowns delivered to your inbox.
