PJM Proposes Curtailing Power to New AI Data Centers During Grid Emergencies

The largest U.S. grid operator has asked federal regulators for the authority to cut power to large data centers during capacity shortages starting in 2027. The proposal aims to protect residential reliability as AI-driven electricity demand outpaces new generation.

By Miguel Carvalho

Share this story

Listen

The artificial intelligence boom has a physical footprint, and it is colliding with the hard limits of the American electrical grid. PJM Interconnection, the operator of the largest wholesale electricity market in the United States, has directed its staff to file a landmark proposal with federal regulators to manage the strain.[1]

PJM manages the flow of power for 67 million people across 13 states and the District of Columbia, a territory that includes Northern Virginia—the world's densest concentration of hyperscale data centers. As these facilities expand to train and run massive AI models, their power requirements are threatening to outpace the grid's ability to supply them.[2][3]

To protect residential and commercial customers from rolling blackouts, PJM's board of managers has approved a framework called the Interim Resource Adequacy Service. If approved by the Federal Energy Regulatory Commission, the policy will fundamentally change how the grid treats major computing loads starting in June 2027.[1][4]

The proposal establishes a strict "bring your own power" mandate for new, massive energy consumers. Any new facility drawing 50 megawatts or more—a threshold that captures virtually every modern AI data center campus—must prove it has secured sufficient independent or contracted power supplies.[2][6]

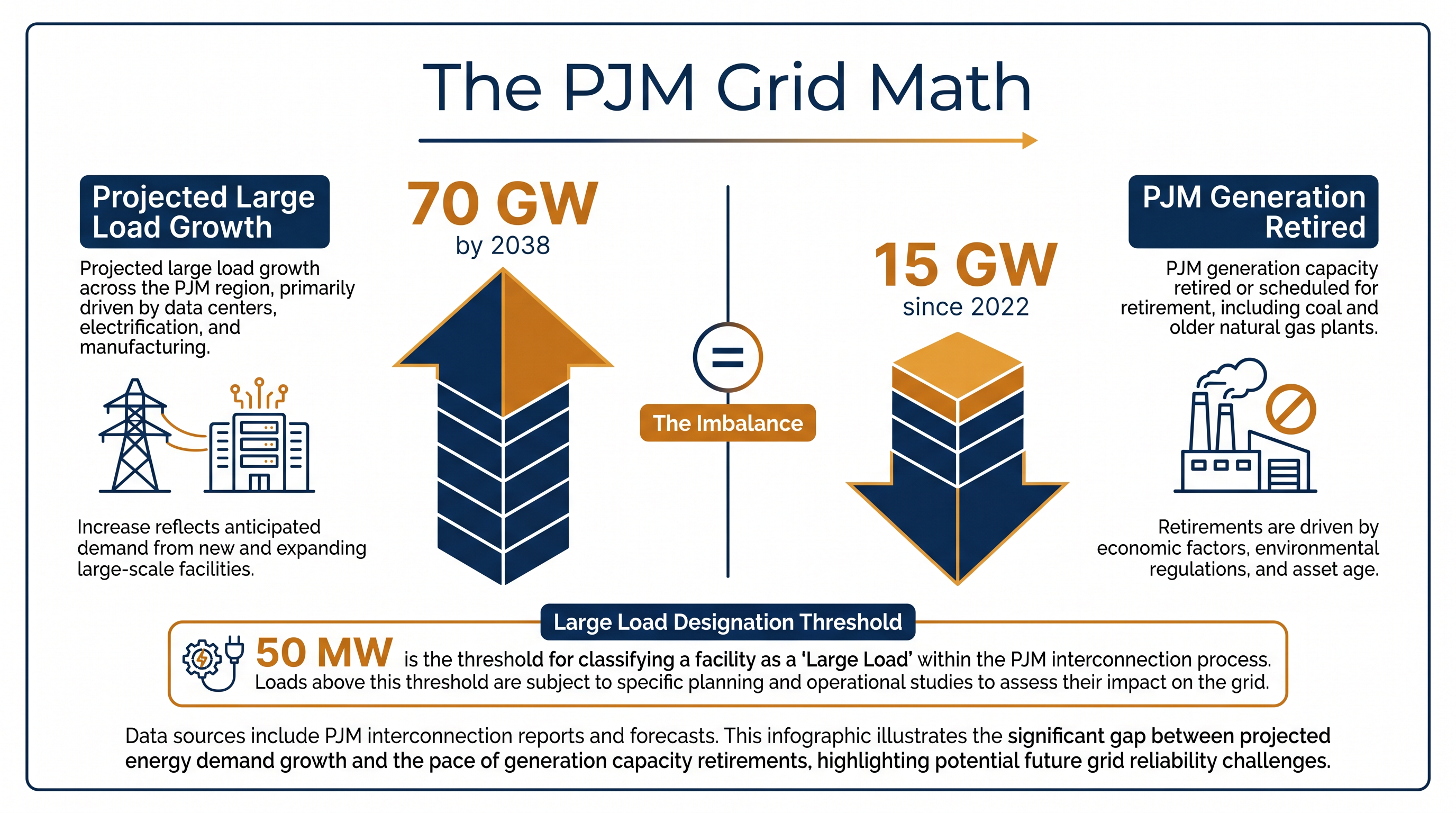

PJM faces a growing gap between forecasted electricity demand and available power generation.

If a 50-megawatt facility fails to secure its own capacity, its electricity access becomes conditional. During a grid emergency, PJM will order these unhedged data centers to drop offline before it asks residential customers to conserve power or initiates rolling blackouts.[1][4]

This represents a two-tier reliability structure. Historically, grid operators have used Pre-Emergency Load Management—paying various industrial customers to voluntarily reduce consumption—as their first line of defense. Under the new rules, unhedged data centers will bear the first-mover risk, facing mandatory curtailment before those broader emergency measures are deployed.[4]

The mechanism of curtailment does not mean grid operators will casually switch off servers without warning. Affected data centers would be compensated for reducing demand, similar to existing demand-response initiatives. Facilities would typically receive an emergency signal and have roughly 15 minutes to transfer their operations to on-site backup power.[5][7]

For most data centers, that backup power comes from industrial diesel generators. While diesel is easy to source and store locally, it introduces significant environmental friction. Federal rules generally limit these generators to 50 hours of operation per year for demand-response programs, and local communities have increasingly pushed back against the localized air pollution they create.[5][7]

PJM's aggressive regulatory posture is driven by stark grid mathematics. The operator forecasts that new large loads will add approximately 70 gigawatts of demand to its system by 2038. Simultaneously, the grid is losing its older, baseload power sources; roughly 15 gigawatts of generation, primarily coal and older natural gas plants, has retired across the PJM footprint since 2022.[2][6]

The grid operator is launching a specialized auction to secure over 6,800 megawatts of new supply.

This divergence between surging demand and retiring supply culminated in PJM's most recent capacity auctions, which failed to secure the system's required 20 percent reserve margin. To fix the immediate shortfall, PJM's board approved a second measure: a Reliability Backstop Procurement.[1][5]

The backstop mechanism will launch a specialized central capacity auction in September and October 2026, targeting 6,831 megawatts of new supply. To incentivize rapid construction, PJM is offering a price ceiling of $555 per megawatt-day and allowing selected power plants to lock in commitments for up to 15 years, provided they come online by 2032.[1][4]

The threat of data center curtailment is not purely theoretical. During severe heat waves in May and July of 2026, the U.S. Department of Energy granted PJM emergency authority to force data centers onto backup generators if necessary to prevent wider grid failures.[7][8]

On July 2, 2026, as peak demand approached an all-time record of 166,147 megawatts, PJM issued an emergency warning to utilities to prepare for the possible curtailment of data centers in Maryland and Virginia. While the grid stabilized and the final step was not needed, the event proved that data centers are now firmly inside the grid's emergency playbook.[7][8]

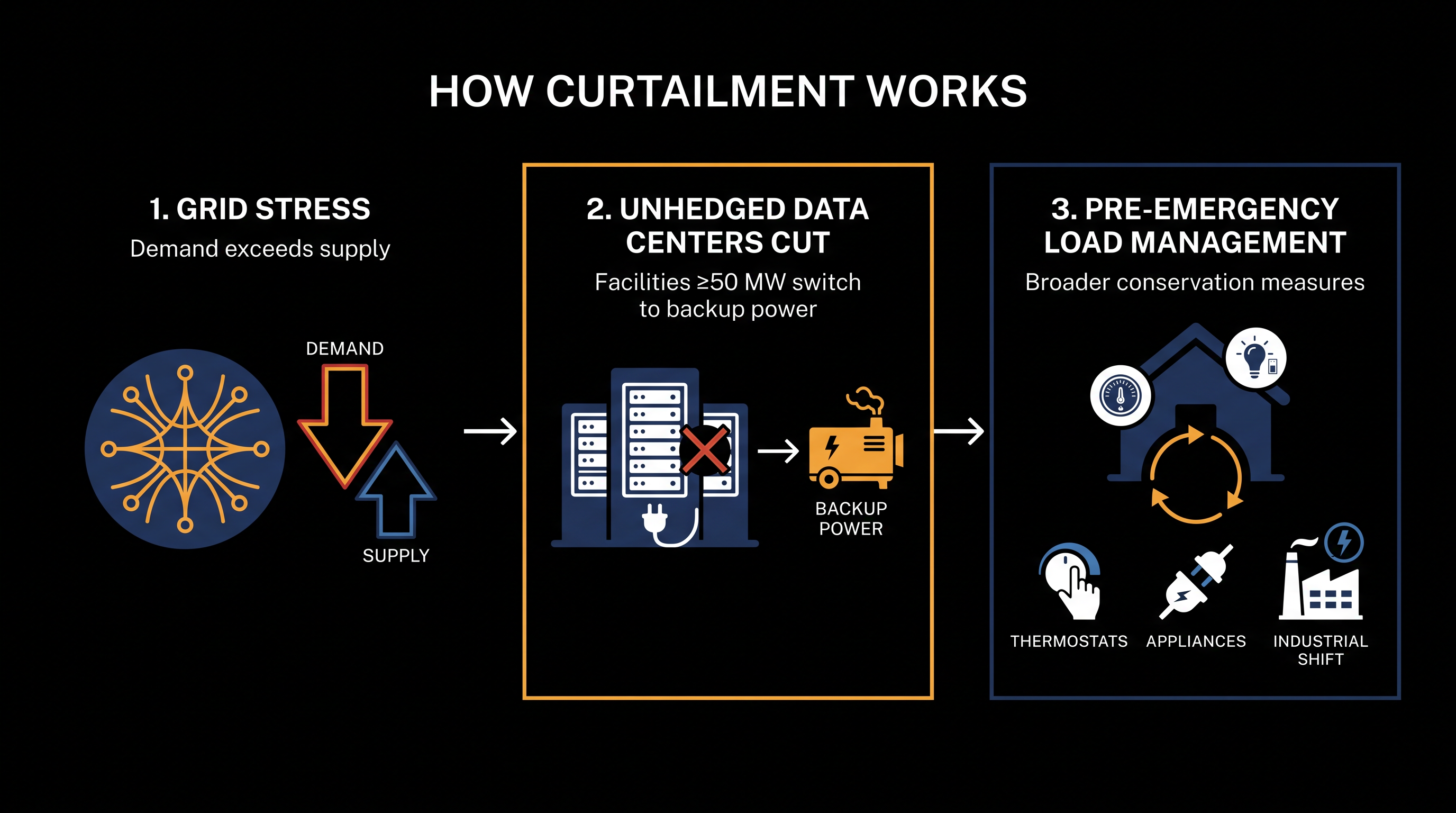

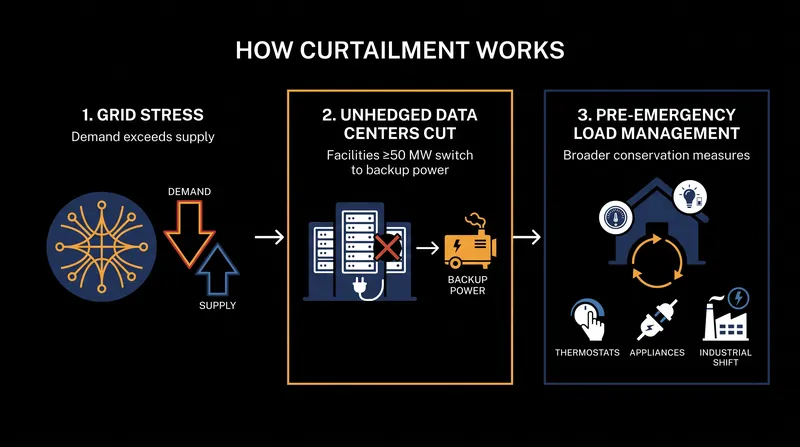

Under the proposal, unhedged data centers would be curtailed before residential conservation measures are deployed.

For the technology sector, the implications are profound. Cloud computing contracts are built around guarantees of continuous uptime and availability zones. PJM's policy signals that computing capacity can now only grow as fast as the physical power system can support it, unless tech companies are willing to accept interruptions.[8]

The June 2027 effective date gives data center operators a narrow window to adapt. Facilities must now decide which workloads can be paused or shifted to other regions during a power crunch, and developers are increasingly looking to fund their own dedicated power sources, such as advanced geothermal or small modular nuclear reactors, to guarantee their AI ambitions are not unplugged.[4][8]

Key points

  • PJM Interconnection has proposed a new rule to curtail power to large data centers during grid emergencies starting in June 2027.
  • The policy applies to new facilities drawing 50 megawatts or more that fail to secure their own independent power supplies.
  • Unhedged data centers would be forced onto backup generators before the grid operator asks residential customers to conserve power.
  • The proposal responds to a forecasted 70-gigawatt increase in large load demand by 2038, colliding with the retirement of older power plants.

What we don’t know

  • Whether the Federal Energy Regulatory Commission (FERC) will approve the proposals without significant modifications.
  • How strictly local environmental regulators will enforce pollution limits on the diesel backup generators used during these curtailments.
  • To what extent this policy will drive cloud providers to relocate planned data centers outside of the PJM footprint.

How we got here

  1. 2022–2026

    Approximately 15 gigawatts of older coal and natural gas generation retires across the PJM footprint.

  2. May 2026

    The Department of Energy grants PJM emergency authority to curtail data centers during a spring heat wave and maintenance crunch.

  3. July 2, 2026

    PJM issues an emergency warning to utilities to prepare for data center curtailments as peak demand approaches an all-time record.

  4. July 27, 2026

    PJM's board directs staff to file the Interim Resource Adequacy Service and Reliability Backstop Procurement proposals with federal regulators.

  5. September 2026

    PJM plans to launch a centralized backstop auction to procure 6,831 MW of new capacity.

  6. June 1, 2027

    The proposed compliance deadline for new large loads to secure independent power or face mandatory curtailment during emergencies.

Grid Operators & Regulators 40%Data Center Developers 35%Environmental Advocates 25%
Grid Operators & Regulators
Prioritizing system-wide reliability and protecting residential consumers from the costs of AI expansion.
Data Center Developers
Emphasizing the need for continuous uptime and faster grid interconnection to maintain U.S. leadership in AI.
Environmental Advocates
Raising alarms about the localized pollution caused by industrial diesel backup generators.

Perspectives this story doesn't cover

  • Local residents near data centers
  • Renewable energy developers facing interconnection delays

Sources

Source coverage

8 outlets

3 viewpoints surfaced

Grid Operators & Regulators 40%Data Center Developers 35%Environmental Advocates 25%
  1. [1]Utility DiveGrid Operators & Regulators

    PJM board proposes capacity auction, data center curtailment to address shortfalls

  2. [2]Network WorldData Center Developers

    Largest US power grid operator proposes curtailing AI data centers during emergencies

  3. [3]TD WorldGrid Operators & Regulators

    PJM Board Directs FERC Filings to Mitigate Data Center Power Demand

  4. [4]MLQ.aiEnvironmental Advocates

    PJM Board Orders FERC Filing to Curtail Data Centers That Don't Self-Supply Capacity

  5. [5]Market BriefsEnvironmental Advocates

    PJM Interconnection to cut power to large data centers during shortages

  6. [6]IT Infrastructure ReportData Center Developers

    PJM proposes curtailing electricity to new AI data centers during grid emergencies

  7. [7]Electric ChoiceGrid Operators & Regulators

    PJM Emergency Orders: Heat Wave Threatens Record Electricity Demand

  8. [8]StartupFortuneData Center Developers

    Grid operators are now treating power-hungry compute as flexible demand

Listen

Comments

Stay informed

Every angle. Every day.

Get Energy stories with full source coverage and perspective breakdowns, free every day.
