Texas Governor Imposes Moratorium on Data Center Construction Over Energy Demand and Grid Strain
Texas has halted grid connection approvals for new data centers pending a comprehensive state audit, responding to an interconnection queue that now exceeds five times the state's record peak power demand.
By Aarav Khanna
Share this story

The Texas electric grid is currently facing an unprecedented 474 gigawatts of interconnection requests, with data centers accounting for 90% of that volume. To contextualize that figure, the Electric Reliability Council of Texas (ERCOT) recorded its all-time historical peak demand of 91.1 gigawatts just weeks prior, on July 22, 2026. The sheer scale of proposed load has prompted state leadership to intervene directly in the infrastructure pipeline, shifting from a posture of rapid accommodation to one of strict regulatory scrutiny.[1][3]
Governor Greg Abbott has ordered the Public Utility Commission of Texas (PUCT) and ERCOT to halt all pending data center grid connections until a comprehensive audit is completed. The directive requires state regulators to verify each facility's operational footprint before granting access to the grid, effectively pausing the rapid expansion of artificial intelligence infrastructure across the state. The move underscores how little concrete information state planners currently possess regarding the long-term resource demands of these hyperscale facilities.[1][2][8]

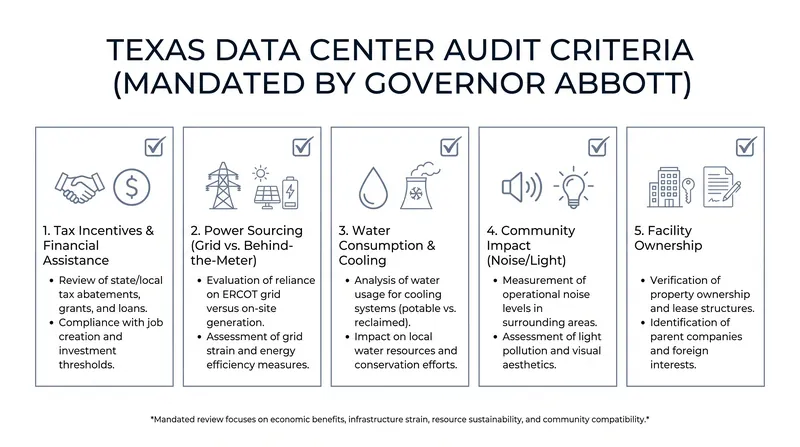

The state's verification process targets five specific areas of data center development. Developers must disclose whether they rely on state or local tax incentives, detail their power sourcing strategy, and explain their water consumption and cooling methods. Additionally, the audit requires proof of community impact mitigation—such as noise and light controls—and full transparency regarding the facility's ownership structure. Any project failing to comply with these disclosure requirements will be denied connection to the Texas grid.[1][3][5]
In response to the directive, ERCOT has delayed its "Batch Zero" review process, a mechanism originally designed to expedite grid connections for ready-to-build projects. State regulators informed the PUCT that up to 300 proposed projects are now on hold for "several months" as they move through the newly mandated audit queue. ERCOT aims to complete its study of this initial batch by April 2027, introducing significant timeline uncertainty for developers who had anticipated a frictionless path to energization.[4][7][8]
The evidence suggests the pause is strictly limited to grid-connected facilities, leaving a substantial loophole for alternative energy strategies. The directive does not ban data center construction outright; rather, it targets pending requests to interconnect to the ERCOT grid. Facilities that build their own on-site power generation—a strategy known as "bring your own generation" or behind-the-meter power—can bypass the traditional interconnection process entirely. Furthermore, the ERCOT region does not cover the entire state, leaving hubs like El Paso exempt from the order.[2][3][5]
Legal and energy analysts note that the audit will likely disrupt projects already under construction and challenge existing contractual obligations between developers and their clients. However, market research indicates that well-capitalized developers who already meet stringent queue requirements will likely pass the audit without issue. The primary effect may be to clear out highly speculative projects that are currently clogging the ERCOT queue, while simultaneously accelerating the industry's shift toward private, off-grid power solutions.[3][4][5]
The state-level pause mirrors growing grassroots resistance at the local level. On August 11, 2026, the Fort Worth City Council unanimously approved the first step toward a 90-day local moratorium on data center zoning and permitting. The city intends to use the pause to evaluate the impact of data centers on local water supplies, noise levels, and infrastructure before drafting long-term regulations. Similar efforts to slow development have been attempted in Hood, Hill, and San Marcos counties over the past year.[1][6]
The Texas directive is part of a broader national trend of states pushing back against the AI power boom. In July 2026, New York enacted a statewide executive order pausing environmental permits for data centers larger than 50 megawatts for up to a year. As of mid-2026, at least 14 other states had data center moratorium bills pending in their legislatures, signaling a widespread regulatory reckoning over the physical footprint of digital infrastructure.[2]
Viewpoints in depth
State Regulators
Prioritizing grid reliability and ensuring that new industrial loads do not compromise power availability for residents.
State officials argue that the sheer volume of data center load requests—representing more than five times the state's peak capacity—poses an existential threat to grid stability if left unchecked. Regulators emphasize that the audit is necessary to gather basic operational data, such as water and power usage, which some developers previously failed to provide voluntarily. The overarching goal is to ensure that data centers fully fund their own infrastructure upgrades rather than passing those costs onto residential ratepayers.
Tech Industry & Developers
Viewing the audit as a necessary hurdle that will ultimately benefit well-capitalized projects by clearing out speculative queue congestion.
Industry trade groups have expressed hope that the state's audit will separate responsible developers from speculative entities that are clogging the interconnection queue. Market analysts point out that while the moratorium introduces short-term uncertainty, heavily backed projects will likely pass the verification process. Furthermore, the regulatory friction is expected to accelerate the industry's shift toward 'behind-the-meter' solutions, where tech companies build or co-locate with their own dedicated power plants to bypass the grid entirely.
Local Communities
Advocating for stricter zoning, noise controls, and resource conservation in the face of rapid industrialization.
Grassroots organizations and city councils have become increasingly vocal about the localized impacts of hyperscale data centers. Municipal leaders are particularly concerned about the massive water requirements for cooling systems, which can strain local aquifers, as well as the constant noise generated by industrial fans. Cities like Fort Worth are using the state-level pause as political cover to enact their own local moratoriums, buying time to draft comprehensive zoning ordinances that protect community resources and quality of life.
Legal & Market Analysts
Highlighting the contractual disruptions and the strategic pivot toward private power generation.
Legal experts warn that the sudden regulatory pause will challenge the ability of developers to meet existing contractual obligations and in-service dates. The uncertainty surrounding the ERCOT 'Batch Zero' timeline forces parties to reevaluate their construction schedules. However, analysts also note that the moratorium strictly applies to grid interconnections, not construction itself. This loophole significantly increases the strategic value of hybrid power solutions and dedicated generation, fundamentally altering how future data centers will be financed and powered in Texas.
Key points
- Governor Greg Abbott has halted ERCOT grid connections for data centers pending a comprehensive state audit.
- Data centers currently account for 90% of the 474 gigawatts of load requests in the Texas interconnection queue.
- The audit will scrutinize developers' tax incentives, water use, power sourcing, and community impacts.
- Up to 300 projects are currently on hold, with the first batch of studies expected to conclude by April 2027.
What we don’t know
- The exact proportion of the 1,800 queued projects that are fully capitalized versus highly speculative.
- Whether the audit process will permanently disqualify non-compliant projects or simply delay their interconnection timelines.
- How rapidly the moratorium will drive tech companies to build unregulated, behind-the-meter power generation to bypass the grid.
How we got here
June 2026
Governor Abbott directs state regulators to ensure data centers fully fund their own electric infrastructure costs.
July 22, 2026
The Texas electric grid hits an all-time historical peak demand record of 91.1 gigawatts.
July 2026
New York enacts a statewide executive order pausing environmental permits for large data centers.
August 3, 2026
Abbott announces the Texas moratorium on data center grid connections pending comprehensive audits.
August 11, 2026
Fort Worth City Council unanimously approves the first step toward a local 90-day data center moratorium.
- State Regulators
- Prioritizing grid reliability and ensuring that new industrial loads do not compromise power availability for residents.
- Tech Industry & Developers
- Viewing the audit as a necessary hurdle that will ultimately benefit well-capitalized projects by clearing out speculative queue congestion.
- Local Communities
- Advocating for stricter zoning, noise controls, and resource conservation in the face of rapid industrialization.
- Legal & Market Analysts
- Highlighting the contractual disruptions and the strategic pivot toward private power generation.
Perspectives this story doesn't cover
- Renewable Energy Developers
- Texas Residential Ratepayers
Sources
[1]The Texas TribuneState RegulatorsData center approvals in Texas halted until audits completed, Gov. Greg Abbott says
Read on The Texas Tribune →
[2]Broadband BreakfastTech Industry & DevelopersTexas Governor Orders Data Center Moratorium
Read on Broadband Breakfast →
[3]Morrison FoersterLegal & Market AnalystsTexas Governor Orders Data Center Moratorium – Disrupting Projects Under Construction and Parties' Contractual Expectations
Read on Morrison Foerster →
[4]EnverusTech Industry & DevelopersTexas Data Center Moratorium | Big Bark, No Bite
Read on Enverus →
[5]Seyfarth ShawLegal & Market AnalystsTexas Pauses Data Center Interconnections
Read on Seyfarth Shaw →
[6]KERA NewsLocal CommunitiesData center moratorium takes first steps after Fort Worth City Council's unanimous vote
Read on KERA News →
[7]Washington ExaminerLocal CommunitiesAbbott's data center construction pause will take 'several months' for up to 300 projects in Texas
Read on Washington Examiner →
[8]Utility DiveState RegulatorsTexas Gov. Greg Abbott has called for an audit of all data centers
Read on Utility Dive →
More in Energy
See all →Grid Reliability
Unplanned Power Plant Outages Fall Sharply During 2026 Winter Storms, FERC-NERC Report Shows
5 sources
Carbon Markets
The Additionality, Permanence, and Leakage Criteria That Validate a Carbon Offset Project
5 sources
Carbon Budget
The 0.45°C Per Trillion Tonne of Carbon (TTC) That Defines the Global Carbon Budget
7 sources
Grid Reliability
Utilities and Regulators Clash Over Grid Costs as Data Center Load Forecasts Surge
6 sources
Comments
Every angle. Every day.
Get Energy stories with full source coverage and perspective breakdowns, free every day.
